Report snapshot

Purpose of the MPR

  • The Major Projects Report (MPR) is an annual review of a selection of the Department of Defence’s (Defence) major equipment acquisition projects. The 2024–25 MPR is the 18th in the series. The MPR is undertaken at the request of the Joint Committee of Public Accounts and Audit (JCPAA) and informs parliamentary scrutiny and the national conversation on major Defence acquisitions.

Key facts

  • In 2024–25, the 21 projects in the MPR were valued at $81.5 billion and represented 32 per cent of total Defence acquisition budget.
  • As at 30 June 2025, the total expenditure of projects in the MPR was $37 billion.
  • Two projects in the MPR were listed as a Project of Concern and seven projects were listed as a Project of Interest.
  • The projects in the 2024–25 MPR cover seven of the 13 capability elements in the 2024 Integrated Investment Program.

What did we find?

  • The Auditor-General concluded nothing came to her attention that caused her to believe the information reviewed in the Project Data Summary Sheets was not prepared in accordance with the 2024–25 MPR Guidelines.
  • There was one emphasis of matter regarding the level of information classified as ‘not for publication’ (NFP) in the PDSSs. Of the 21 projects, 19 PDSSs contained information marked NFP.
  • Defence introduced Minimum Viable Capability (MVC) as a new milestone for one project, which had yet to determine dates for Initial Operational Capability (IOC) or Final Operational Capability (FOC).
  • There were 108 risks and issues across the 21 projects, of which 50 were downgraded or retired and will be removed in 2025–26 MPR.
  • The average slippage across each project is around two years.

1 of 21

projects disclosed that it would have insufficient funds to deliver the project to agreed scope.

8 of 21

projects have no total schedule slippage.

97.7%

was the expected delivery against project scope across the 21 projects (an increase of 3.2 per cent from 2023–24).

Due to the complexity of material and the multiple sources of information for the 2024–25 Major Projects Report, we are unable to represent the entire document in HTML. You can download the full report in PDF or view selected sections in HTML below. PDF files for individual Project Data Summary Sheets (PDSS) are also available for download.

!Part 1. ANAO Review and Analysis

1. Background

Introduction

The 2024–25 MPR is the 18th in the series and has reviewed a total of 63 major projects since its inception in 2008–09.

1.1 In the early 2000s, parliamentary interest in Defence acquisition projects was high. In 2003, the Senate Foreign Affairs, Defence and Trade Reference Committee found that there was poor visibility on the progress of major projects. The Committee recommended that the Senate request the Auditor-General to produce an annual report on the progress of major Defence projects.1

1.2 In 2006, the Joint Committee of Public Accounts and Audit (JCPAA) recommended that the Australian National Audit Office (ANAO) produce an annual report based on data supplied by Defence on the progress of the top 30 capital equipment projects. The first report published in 2008–09 covered nine major projects, with the intention of reporting up to 30 in subsequent years.2 The 2024–25 Major Projects Report is the 18th edition in the series, which has now reviewed 63 major projects since its inception.

1.3 The Defence’s Capability Acquisition and Sustainment Group (CASG) manages the introduction and development of new specialist military equipment for the Australian Defence Force (ADF), while the Naval Shipbuilding and Sustainment Group (NSSG) has been responsible for maritime capabilities since October 2022.

1.4 The 2024–25 Major Projects Report (MPR) contains Defence data and commentary on a selection of 21 of its major specialist military equipment acquisition projects, and a Project Data Summary Sheet (PDSS) for each project. Alongside this is an independent assurance and analysis by ANAO on key areas such as cost performance, schedule performance and capability/scope delivery.

Selected projects

The 2024–25 MPR covers 21 major projects representing $81.5 billion in approved budget — 16 of which are managed by CASG and five by NSSG.

1.5 The 21 projects in the 2024–25 MPR were selected based on criteria endorsed by the JCPAA through the 2024–25 MPR Guidelines. This represents approximately $81.5 billion in approved budget and accounted for 32 per cent of the total Defence acquisition budget. Of all projects managed by CASG and NSSG, the projects in the 2024–25 MPR represent 51 per cent of their total budget.

1.6 Table 1.1 outlines the 21 projects selected for review and their government-approved budgets as at 30 June 2025, listed in order of approved budget.

Table 1.1: 2024–25 MPR — selected projects and approved budgets as at 30 June 2025

Project number

Project name

Project abbreviation

Acquisition categorya

ACAT ratingb

Approved budget ($m)

SEA5000h

Hunter Class Frigate Design and Construction

Hunter Class Frigate

Other

I

26,055.3

AIR6000 Phase 2A/2B

New Air Combat Capability

Joint Strike Fighter

GtG

I

16,708.1

LAND400 Phase 2

Mounted Combat Reconnaissance Capability

Combat Reconnaissance Vehicles

Other

I

5,775.6

LAND4503

AH-64E Apache Attack Helicopter

Apache Attack Helicopterc

FMS

II

4,685.0

SEA1180 Phase 1h

Offshore Patrol Vessel

Offshore Patrol Vessel

Other

II

3,707.4

AIR5349 Phase 6

Advanced Growler - Airborne Electronic Attack Upgrade

Advanced Growler

GtG

II

3,287.0

AIR7001

MQ-4C Triton

MQ-4C Tritond

GtG

II

2,444.3

AIR555

MC-55A Peregrine

MC-55A Peregrinee

FMS

II

2,399.4

LAND907

Armoured Combat

Armoured Combatf

FMS

II

2,388.4

LAND8113 Phase 1

Long Range Fires

Long Range Fires

FMS

II

2,388.5

SEA9100 Phase 1

Improved Embarked Logistics Support Helicopter

IE Logistics Support Helicopter

FMS

III

2,086.1

LAND121 Phase 4

Protected Mobility Vehicle – Light (PMV-L)

Hawkei

Other

I

1,975.5

AIR2025 Phase 6

Jindalee Operational Radar Network

JORN Mid-Life Upgrade

Other

II

1,250.4

LAND19 Phase 7B

Short Range Ground Based Air Defence

SRGB Air Defence

Other

II

1,245.7

AIR6500

Integrated Air and Missile Defence Command and Control

IAMD Command and Controlg

Other

I

1,097.2

AIR5431 Phase 3

Civil Military Air Traffic Management System

CMATS

Other

I

1,010.9

LAND200 Tranche 2

Battlefield Command System

Battlefield Command System

Other

I

972.7

SEA1439 Phase 5B2h

Collins Class Communications and Electronic Warfare Improvement Program

Collins Comms and EW

Other

II

617.8

SEA3036 Phase 1h

Pacific Patrol Boat Replacement

Pacific Patrol Boat Repl

Other

II

568.5

SEA1442 Phase 4

Maritime Communications Modernisation

Maritime Comms

Other

II

443.2

SEA1448 Phase 4Bh

ANZAC Air Search Radar Replacement

ANZAC Air Search Radar Repl

Other

II

429.5

Total (21 projects)

81,536.5

Note a: For the purposes of the analysis of this report, the ANAO has categorised projects based on their lead contract or primary acquisition arrangement. Foreign Military Sale (FMS) is an agreement between the US Government and a foreign government. The government-to-government (GtG) category is where the Australian Government and a foreign government enter into an arrangement, including co-operative agreements. ‘Other’ approaches typically involve direct contracts with commercial suppliers.

Note b: Defence assigns the Acquisition Categorisation (ACAT) level by project acquisition complexity in four levels of descending risk, from ACAT I, which is characterised by very high levels of complexity and technical risk, to ACAT IV, which has the lowest levels of complexity. The complexity of a project may vary over its life cycle.

Note c: In the 2024–25 MPR Guidelines, this project was titled LAND4503 Phase 1 Armed Reconnaissance Helicopter (ARH) Replacement (ARH Replacement).

Note d: In the 2024–25 MPR Guidelines, this project was titled AIR7000 Phase 1B MQ-4C Triton Remotely Piloted Aircraft System (MQ-4C Triton).

Note e: In the 2024–25 MPR Guidelines, this project was titled AIR555 Phase 1 Airborne Intelligence, Surveillance, Reconnaissance and Electronic Warfare (ISREW) Capability (Peregrine).

Note f: In the 2024–25 MPR Guidelines, this project was titled LAND907 Phase 2/LAND8160 Phase 1 Main Battle Tank Upgrade, Combat Engineering Vehicles (Heavy Armoured Capability).

Note g: In the 2024–25 MPR Guidelines, this project was titled AIR6500 Phase 1 Joint Air Battle Management System (JABMS).

Note h: These projects are managed by NSSG, all other projects are managed by CASG.

Source: ANAO analysis of the 2024–25 PDSSs.

National Defence Strategy and Integrated Investment Program

The projects in the 2024–25 MPR cover seven of the 13 capability elements outlined in the 2024 Integrated Investment Program.

1.7 The 2023 Defence Strategic Review3 recommended a strategic update be released every two years through a National Defence Strategy.4 The inaugural 2024 National Defence Strategy (NDS) provides a new approach to addressing Australia’s most significant strategic risks through a more integrated, focused Defence force. The NDS sets out six key capability effects that Defence needs to deliver in order to achieve this objective.5

1.8 The 2024 Integrated Investment Program (IIP) sets out 13 specific capabilities the Government will invest in to deliver an integrated, focused force across its five capability domains to give effect to the NDS.6 Defence’s five capability domains are maritime, land, air, space and cyber and the 2024–25 MPR covers the maritime (sea), land and air domains. Future iterations of the MPR may need to consider the additional domains of space and cyber.

1.9 Table 1.2 provides the ANAO’s assessment of coverage across the 2024–25 MPR and the investment priorities of the 2024 IIP.

Table 1.2: Coverage of Defence acquisitions in the 2024–25 MPR when compared with the 2024 IIP capability investment priorities

Capability element in the 2024 IIP

ANAO assessment of MPR coverage

2024–25 MPR projects

Total MPR project budget ($m)a

Undersea warfare

SEA1439

617.8

Maritime capabilities for sea denial and localised sea control operations

SEA5000, SEA1180, SEA3036, SEA9100

32,417.3

Targeting and long range strike

LAND8113, LAND19

3,634.2

Space and cyber

Amphibious capable combined-arms land system

LAND121, LAND907, LAND4503, LAND400

14,824.5

Expeditionary air operations

AIR5439, AIR6000, AIR555, AIR7001

24,838.8

Missile defence

AIR6500, AIR2025, SEA1448

2,777.1

Theatre logistics

Theatre command and control

LAND200, AIR5431, SEA1442

2,426.8

Guided weapons and explosive ordnance

Enhanced and resilient northern bases

Enterprise infrastructure

Investment in enterprise data

Key:  represents approximately a quarter of the capability element covered by MPR projects.

represents approximately half of the capability element covered by MPR projects.

no elements of the capability are covered by MPR projects.

Note a: The budget figures are total approved project budget as at 30 June 2025.

Source: ANAO analysis of the 2024 IIP and 2024–25 MPR projects list and budgets in the PDSSs.

Rationale for undertaking the review

The MPR is commissioned by the JCPAA in the public interest to improve accountability and transparency.

1.10 The JCPAA has stated that the objective of the MPR is ‘to improve the accountability and transparency of Defence acquisitions for the benefit of Parliament and other stakeholders.’7 The JCPAA commissions the MPR in the public interest, for the benefit of users of the report inside and outside the Parliament. The MPR informs parliamentary scrutiny and the national conversation on major Defence acquisitions.

1.11 Defence’s major acquisition projects are the subject of parliamentary and public interest due to their: high cost and contribution to national security in a changing strategic environment; the challenges involved in completing them within the specified budget, schedule and to the required capability; and their contribution to industrial and employment policy objectives.

Conduct of the review

The MPR is a limited assurance review, which validates the accuracy and completeness of information provided by Defence in the PDSSs.

1.12 The ANAO has reviewed the PDSSs prepared by Defence as a ‘priority assurance review’ under subsection 19A(5) of the Auditor-General Act 1997 (the Act), which allows the ANAO full access to the information gathering powers under the Act. The level of assurance that the ANAO aims to provide differs depending on whether the engagement is a performance audit (a reasonable assurance engagement) or an assurance review (a limited assurance engagement). The ANAO’s review of the PDSSs is a limited assurance engagement which is performed under ANAO Auditing Standards, which includes ASAE 3000 Assurance Engagements.8 A limited assurance engagement provides a lower level of assurance than a performance audit based on the procedures performed. In performing the limited assurance review of the PDSSs, we primarily relied on representations made by entity’s officials and examination of documents to validate the accuracy, completeness and governance of the information presented in the PDSSs.

1.13 The scope of the MPR engagement is set out in the 2024–25 MPR Guidelines9 (included in Part 4 of this report), endorsed by the JCPAA following consultation between the ANAO and Defence. The key roles and responsibilities of the JCPAA, Auditor-General and Defence in delivering the MPR are set out in Figure 1.1.

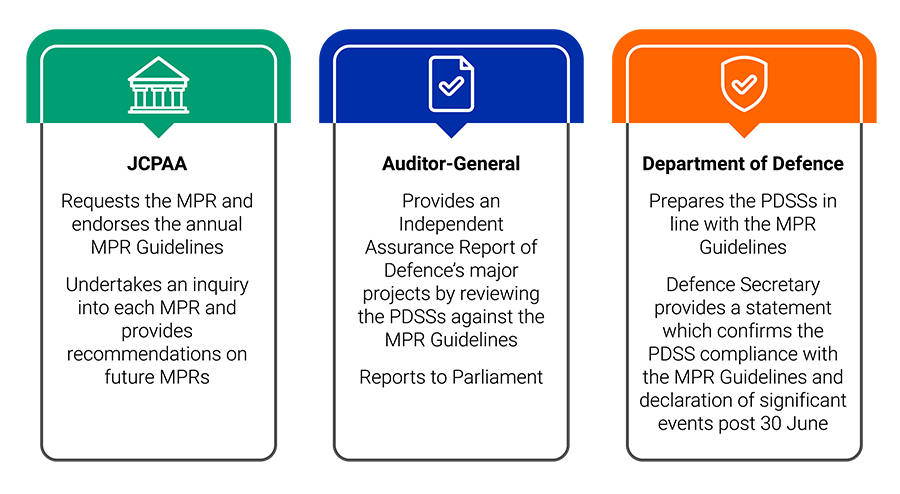

Figure 1.1: Major Projects Report — Key roles and responsibilities

Figure 1.1: Major Projects Report — Key roles and responsibilities

Source: ANAO analysis.

1.14 The MPR is tabled in the Parliament and is structured into four parts.

  • Part 1 — includes the ANAO chapters which cover review and analysis, and the ANAO’s assessment of selected Defence systems and controls, including the governance and oversight in place to ensure appropriate project management.
  • Part 2 — comprises Defence’s commentary, analysis and appendices, also referred to as the Defence MPR (not included within the scope of the Independent Assurance Report by the Auditor-General).

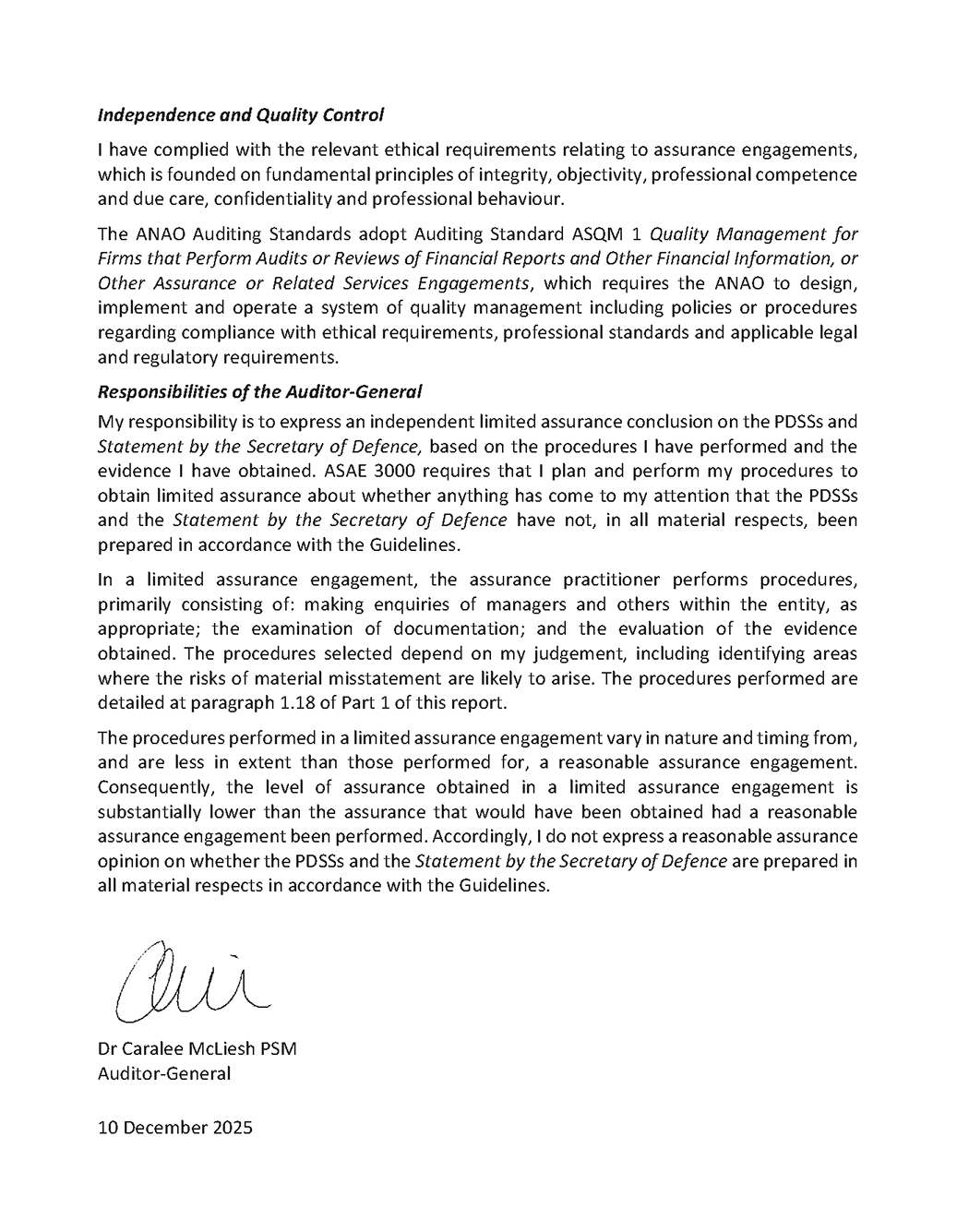

  • Part 3 — incorporates the Auditor-General’s Independent Assurance Report, the Statement by the Secretary of Defence, and the PDSSs prepared by Defence.
  • Part 4 — reproduces the Major Projects Report Guidelines endorsed by the JCPAA, which provide the template for the PDSSs.

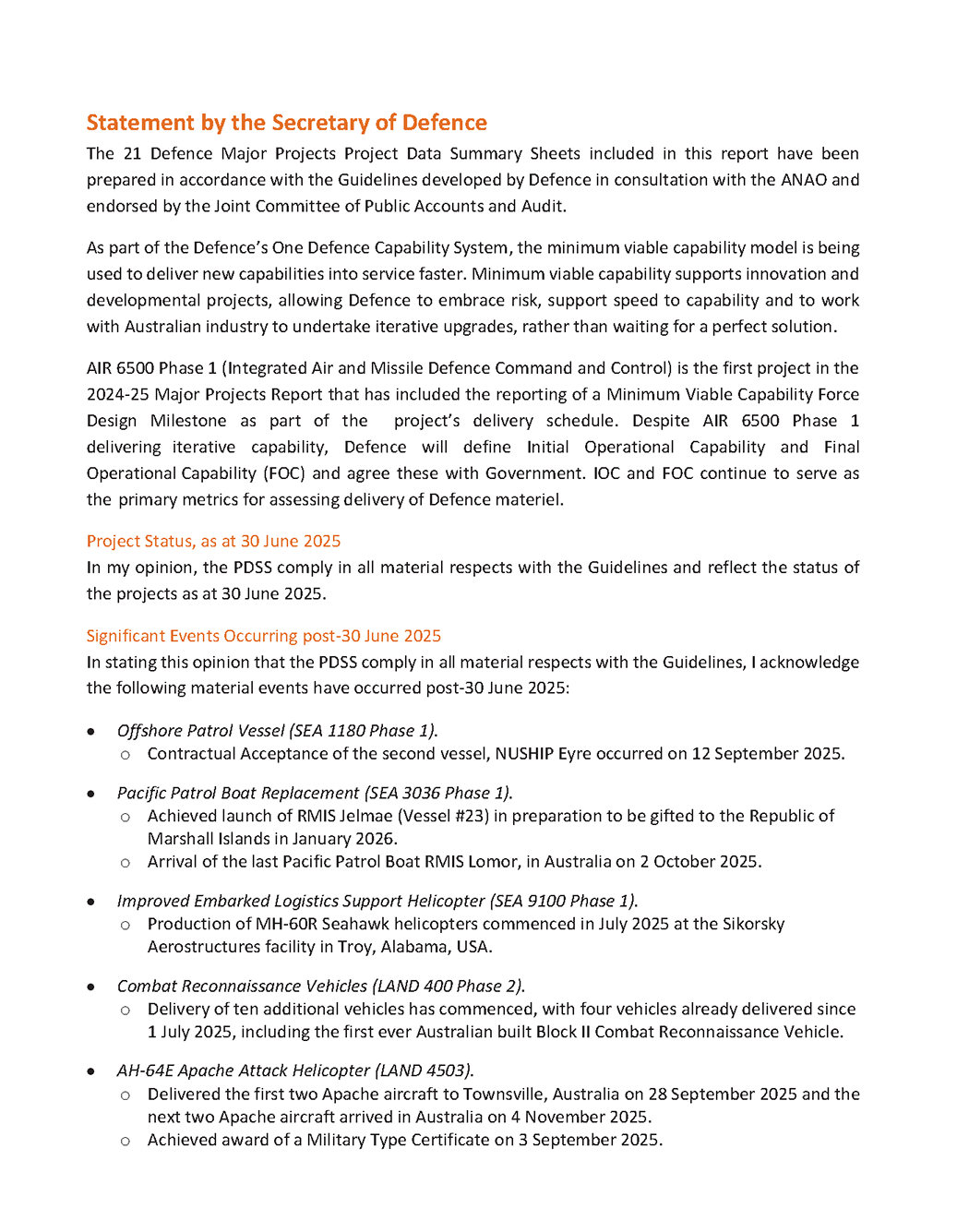

1.15 The Statement by the Secretary of Defence provides the final status of the 21 major projects as at 30 June 2025. The ANAO’s review includes an assessment of this statement, of which the PDSSs form part, and consideration of declared significant events occurring in projects after 30 June 2025 and before tabling of the MPR in the Parliament.

1.16 The Auditor-General’s Independent Assurance Report has previously excluded from scope several components of the PDSSs. For the 2024–25 MPR, all components of the PDSSs are included in scope of the Independent Assurance Report. The MPR now includes the following components that were previously excluded:

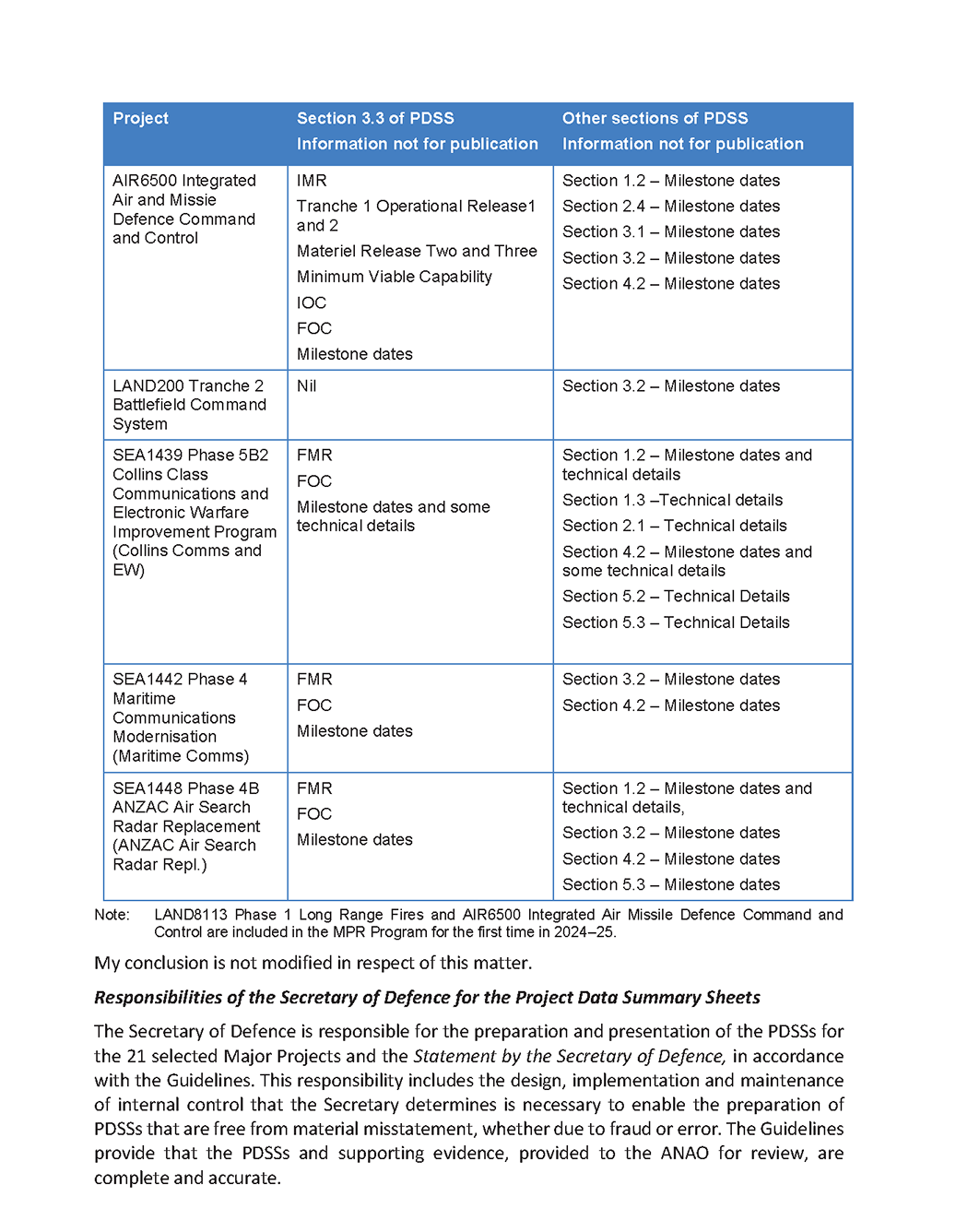

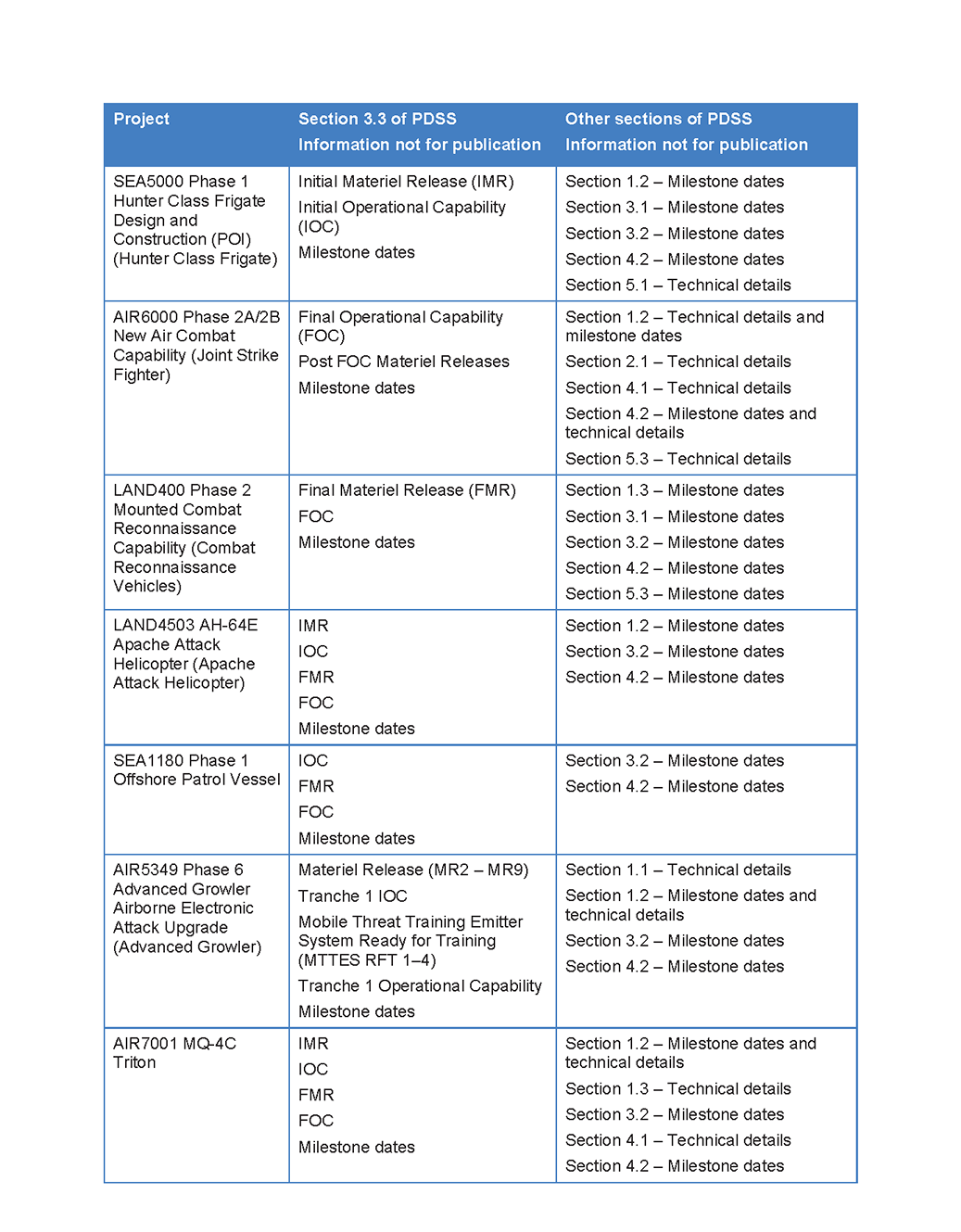

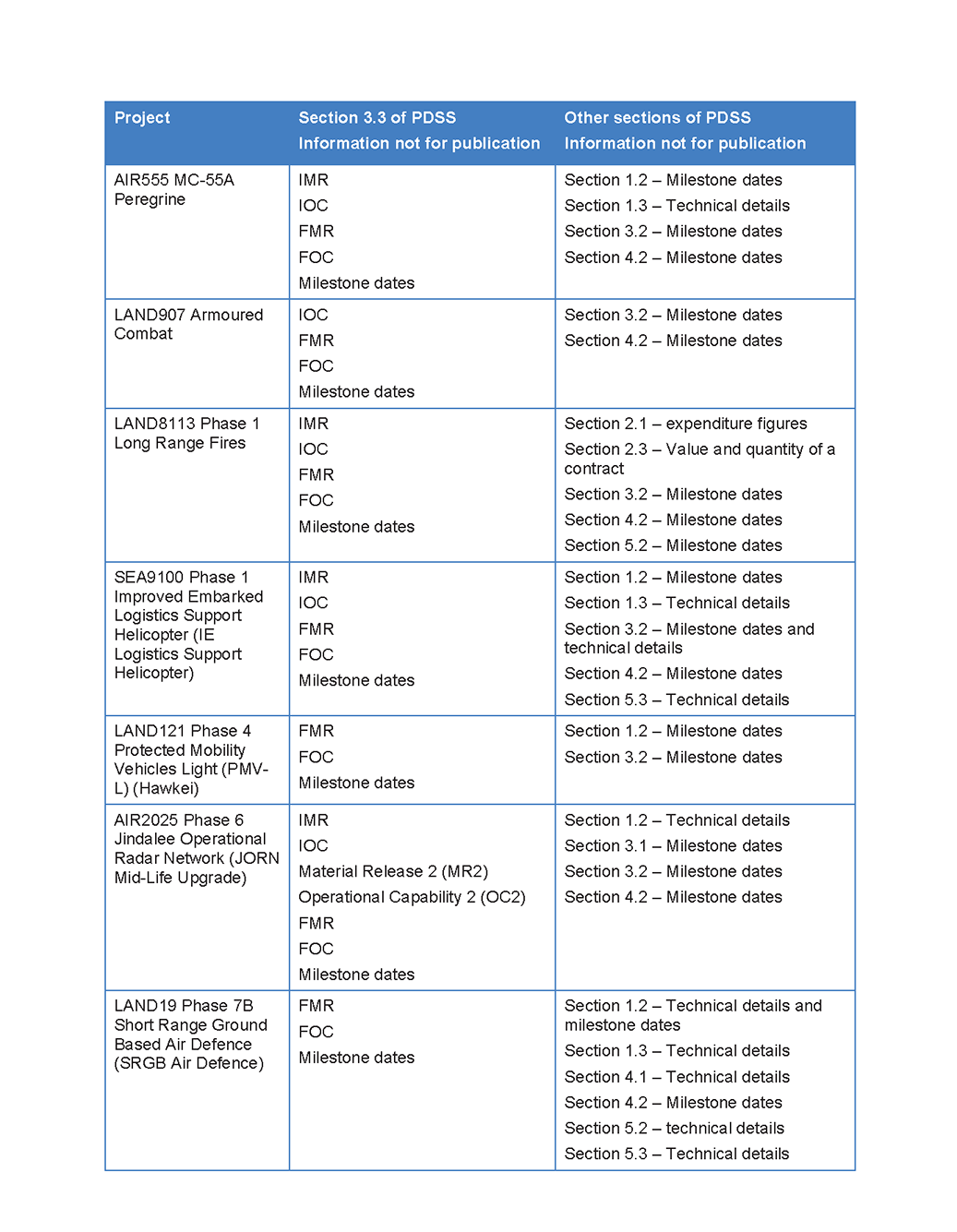

  • Sections 1.2 and 4.1 — Current status and Measures of Materiel Capability/Scope Delivery Performance;
  • Sections 1.3 and 5 — Major Risks and Issues;
  • Section 2.4 – Australian Industry Capability (AIC); and
  • forecast dates in the PDSSs.

1.17 The ANAO’s review was conducted in accordance with the ANAO Auditing Standards at a cost of approximately $1.6 million. This is a reduction in cost from prior years, reflecting process efficiencies identified by the ANAO and improvements in the quality of PDSSs submitted by Defence.

Review methodology

The review methodology sets out the ANAO’s approach to conducting the limited assurance review of the PDSSs.

1.18 The ANAO’s review of the information presented in the PDSSs include:

  • assessing Defence’s internal systems, controls, and assurance mechanisms;
  • reviewing documentation and engaging with Defence personnel;
  • considering feedback from industry contractors on draft PDSS content;
  • verifying Defence’s representations that support lessons learned;
  • analysing project data across cost, schedule, capability/scope delivery and risks;
  • evaluating senior management attestations regarding PDSS accuracy and completeness;
  • reviewing financial assurance statements from the Chief Finance Officer;
  • confirming security-related decisions by the Vice Chief of the Defence Force regarding the non-disclosure of certain information in the PDSSs; and
  • reviewing the Statement by the Secretary of Defence, including post–30 June 2025 events and related representations.

1.19 When reviewing the PDSSs, the ANAO also considered the following Defence acquisition governance arrangements: Independent Assurance Review (IAR) process; Projects of Interest and Projects of Concern lists; Defence risk management policies and guidance, reporting and record-keeping (particularly of government decisions); Smart Buyer Framework; and the AIC requirements.

1.20 In addition to the review procedures performed in relation to the PDSSs, the ANAO has undertaken an analysis of the PDSSs for selected elements of project performance.

Auditor-General and Joint Committee of Public Accounts and Audit reports

Auditor-General reports tabled in the Parliament 2024–25

The Auditor-General tabled three performance audits that related to projects in the 2024–25 MPR, and another audit commenced in 2024–25.

1.21 The ANAO’s Annual Audit Work Program includes performance audits of Defence’s procurement of major specialist military equipment. Key areas of deficiency generally reported in performance audits includes: the need to improve focus on value for money; the completeness of advice; records management; and the management of probity.

1.22 In 2024–25, the ANAO undertook three performance audits related to projects included in the MPR, which provide a ‘reasonable assurance’ level review.

  • Auditor-General Report No. 50 2024–25 Department of Defence’s Sustainment of Canberra Class Amphibious Assault Ships (Landing Helicopter Dock) found that Defence’s arrangements for the sustainment of Navy’s Landing Helicopter Dock ships were partly effective and made nine recommendations aimed at improving: the transition from acquisition to sustainment; the management of sustainment; and contract management.10
  • Auditor-General Report No. 46 2024–25 Management of the OneSky Contract found that the arrangements for Airservices Australia’s management of the joint civil–military air traffic management system (CMATS) contract were partly effective. The audit made five recommendations relating to Airservices: contract management plan; risk management; documentation of contract variations; performance management; and guidance for gifts, benefits and hospitality.11
  • Auditor-General Report No. 31 2024–25 Maximising Australian Industry Participation through Defence Contracting found that Defence had not maximised Australian industry participation through the administration of its contracts. The audit made nine recommendations to Defence aimed at improving governance, assurance and reporting arrangements.12

1.23 In 2024–25, the ANAO commenced a performance audit on the effectiveness of Defence’s procurement of Infantry Fighting Vehicles (LAND400 Phase 3).13 The audit will examine whether Defence conducted an effective tender process and established effective contract arrangements.14

1.24 Defence is also subject to ANAO financial statements auditing as required by the Public Governance, Performance and Accountability Act 2013. Financial statements auditing includes aggregate financial reporting and disclosures relating to supplier expenses, assets under construction, and specialist military equipment. The valuation of specialist military equipment, general assets and assets under construction are audit focus areas. Financial statements audits provide a ‘reasonable assurance’ level.

1.25 From 2024–25, the ANAO commenced auditing Defence’s annual performance statements. A key activity in Defence’s Corporate Plan 2025–29 includes performance measure ‘6.1 — Defence is delivering the right future capability at the right time within the Integrated Investment Program to ensure it is equipped to respond to future security challenges as directed by the NDS’. This measure is supported by three targets.

  • Target 6.1a: 80 per cent or more of approved Integrated Investment Program projects by domain are on track to deliver the scope approved by Government.
  • Target 6.1b: 80 per cent or more of approved Integrated Investment Program projects by domain are on track to deliver within the schedule approved by Government.
  • Target 6.1c: 80 per cent or more of approved Integrated Investment Program projects by domain are on track to deliver with the cost (including contingency) approved by Government.15

1.26 In Defence’s 2024–25 annual performance statements, against performance measure target 6.1b, Defence reported a result of ‘substantially achieved’. Defence’s performance reporting for project slippage against performance measure 6.1 is against amended budgets and timelines that have been approved by government decisions. In contrast, analysis of project slippage in the MPR measures project slippage against the original government approved FOC milestone, regardless of whether the decisions to amend the timelines were approved by government or not (as measured by the MPR through project-level FOC reporting). In 2024–25, the ANAO issued an unmodified audit report on the Defence Annual Performance Statements with an Emphasis of Matter drawing attention to the methodology used to calculate the results for scope, schedule and cost targets of performance measure 6.1.

JCPAA Inquiries into the Major Projects Report

The JCPAA made four recommendations with respect to the 2022–23 MPR — two for both Defence and the ANAO and two for Defence.

1.27 The JCPAA’s Inquiry into the 2022–23 Major Projects Report focussed on: the increased non-disclosure of information in the PDSSs and the need to maintain transparency; the lessons learned process; the Australian Industry Capability plans; the implementation of Defence’s risk management system; use of contingency funds; and the use of terminology. Report 507—Defence 2022–23 Major Projects Report16, was tabled in December 2024 and the JCPAA made four recommendations for the ANAO and Defence.

1.28 The JCPAA has held an inquiry into the matters contained and associated with Auditor-General Report No. 20 2024–25: 2023–24 Major Projects Report.17 The inquiry report is yet to be published.

2. Major projects review

Summary of analysis

The ANAO is unable to publish full longitudinal analysis due to Defence’s non-disclosure of key milestone data in PDSSs. Key performance indicators have improved since 2023–24.

2.1 Table 2.1 summarises the Project Data Summary Sheet (PDSS) aggregate data on Defence’s progress toward delivering the 21 projects in the review. This includes in-year data on cost, schedule and capability/scope delivery performance as well as total number of risks and issues published in the PDSSs.

Table 2.1: Summary of aggregate Project Data Summary Sheet key elements 2024–25a

Major Projects Report 2024–25

Number of projects

21

Cost performance

$m

Total approved budget as at 30 June 2025

81,536.5

Total approved budget at final government second pass approvalb

74,661.4

Total expenditure against total approved budget

37,355.9

Total in-year expenditure against in-year budget

5,329.5

Total budget variation since initial government second pass approval

37,254.4

Total budget variation since final government second pass approval

6,875.1

In-year approved budget variation

775.9

Schedule performance

months

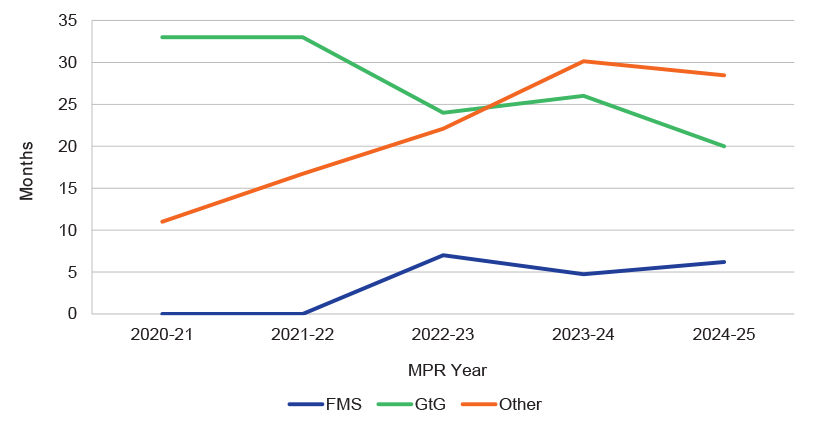

Average slippage (across all projects)c e

21

Median slippage (across all projects)d e

21

In-year schedule slippage

4

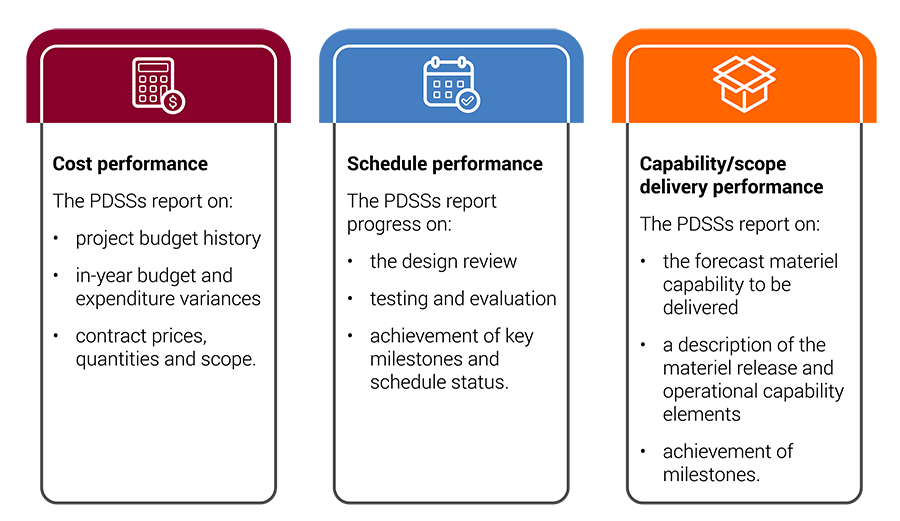

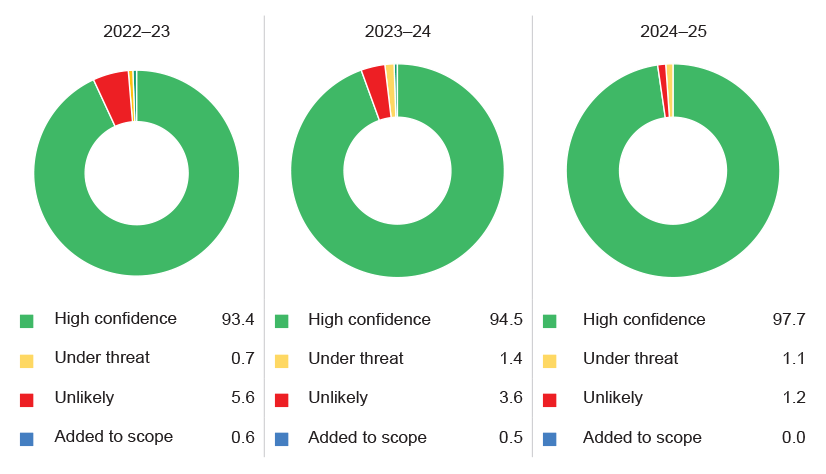

Capability/scope delivery performance (Defence reporting)

%

High level of confidence of delivery

97.7

Under threat, considered manageable

1.1

Unlikely to be met or removed from scope

1.2

Added to scope

0

Risks and issuesf

Total reported risks

74

Downgraded or retired risks

27

Total reported issuesg

34

Downgraded or retired issues

23

Note a: In prior MPRs, this table reported three years of longitudinal analysis, however the 2024–25 data is not comparable to prior years due to changes in the projects being reviewed in the MPR, and the non-disclosure of key milestone data in PDSSs.

Note b: Government second pass approval endorses a specific capability solution and provides authority for a project to begin acquisition.

Note c: Slippage refers to a delay in the current forecast date compared to the original government approved date of FOC. These figures exclude delays to a project’s schedule that do not result in slippage past the original government approved date, and schedule reductions over the life of the project.

Note d: Median slippage is a measure of central tendency and is not impacted by extreme outliers, for example projects that had a significant level of slippage.

Note e: Slippage analysis excludes two projects which did not have settled FOC dates as at 30 June 2025. SEA5000 Hunter Class Frigate did not have an FOC milestone approved by government and AIR6500 Integrated Air and Missile Defence Command and Control project has yet to define FOC.

Note f: Downgraded risks or issues are those previously reported in the PDSSs and internally managed by Defence as ‘High’ or above which are now downgraded to ‘Medium’ or lower. Retired risks or issues are those that no longer require management by Defence. All downgraded and retired risks and issues will be removed from subsequent MPRs.

Note g: One project (SEA9100 IE Logistics Helicopter) included an issue marked as ‘not for publication’.

Source: ANAO analysis of the 2024–25 PDSSs.

2.2 Budget variations since initial Second Pass Approval total $37,254.4 million. Of this, AIR6000 Phase 2A/2B Joint Strike Fighter and SEA5000 Hunter Class Frigate account for 80.9 per cent ($30,134.7 million) due to an increase in 58 aircraft for AIR6000, and approval to commence construction of one to three ships for SEA5000 (see paragraph 4.3).

2.3 The ANAO undertook trend analysis on 14 projects18 that have been in the MPR across five consecutive years, from 2020–21 to 2024–25 (further data is available from paragraph 4.38). The reason for selecting the 14 projects was to ensure comparative analysis by excluding projects entering or exiting the MPR.

2.4 Project slippage is calculated based on the variance between original government second pass approval (when government originally expected capability to be available) and current project completion forecasts (FOC milestone). As the projects in the MPR are delivered concurrently, measuring median and average slippage is a measure of project delivery performance across the 21 projects. The median value, by excluding outliers, provides an indication of the typical impact on achieving FOC on a project-level basis. The median slippage and the average slippage are 21 months respectively (see Table 2.1). This analysis excludes SEA5000 Hunter Class Frigate, which did not have an FOC milestone approved by government and AIR6500 Integrated Air and Missile Defence Command and Control, which has yet to define FOC. The sum of individual project slippage across the 21 projects is 404 months. AIR5431 Phase 3 CMATS represents the largest contributor, accounting for 23 per cent (93 months) of the slippage (see paragraphs 4.20 and 4.21).

2.5 During the 2024 IIP rebuild process, some projects were rephased as programs or tranches and the baseline for FOC was reset with the introduction of new Material Acquisition Agreements (MAAs). This means that the schedule performance for affected projects is generally reset at zero within the longitudinal schedule analysis. Project-level longitudinal analysis is unable to be conducted across affected projects when project delivery milestones have been adjusted without risking disclosure of information previously marked as not for publication (NFP) in prior years.

2.6 Section 4 on the PDSSs presents a forecast of the capability to be delivered for the project, by FOC, and does not represent schedule or budget performance. Materiel capability is visualised by a traffic light rating system of ‘green’, ‘amber’ or ‘red’. Within this, section 4.1 provides a likelihood forecast of the capability to be delivered by the project against the FOC milestone. A description of the materiel release and operational capability elements for FOC is defined in Section 4.2 of the PDSS.

2.7 Figure 2.1 provides a high-level longitudinal summary of capability/scope disclosures across the 14 projects, comparing the average performance from 2020–21 to 2023–24, to the in-year performance in 2024–25. This shows there has been an improvement in delivery confidence levels for scope and capability, which have seen a year-on-year improvement in reported ‘green’ capability. For example, in the SEA domain, the high level of delivery confidence (‘green’ rating) was 99.7 per cent for 2024–25, which is significantly higher than the average reported ‘green’ rating from 2020–21 to 2023–24.

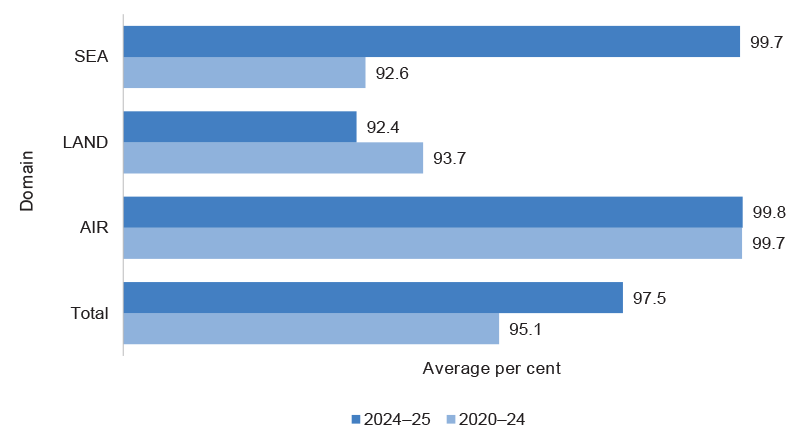

Figure 2.1: Average high level of confidence in capability by domain, for projects consistent in the MPR from 2020–21 to 2023–24 compared to 2024–25

Figure 2.1: Average high level of confidence in capability by domain, for projects consistent in the MPR from 2020–21 to 2023–24 compared to 2024–25

Source: ANAO analysis of the 2020–21 to 2024–25 PDSSs.

2.8 A comparison to the 2023–24 MPR explaining the differences in the above analysis is unable to be published by the ANAO due to the non-disclosure of FOC dates, forecast dates and other capability related information by Defence.

Summary of the Auditor-General’s conclusion

2.9 The Auditor-General’s Independent Assurance Report for 2024–25 is found in Part 3 of this report. Based on the review procedures and the evidence obtained, the Auditor-General concluded that nothing came to her attention that caused her to believe that the information reviewed was not prepared in accordance with the 2024–25 MPR Guidelines.

2.10 The Auditor-General also included an Emphasis of Matter paragraph to draw attention to disclosures within the Statement by the Secretary of Defence (found in Part 3 of this report) that information has been removed from the relevant PDSSs due to Defence’s assessment that the information would or could reasonably be expected to cause damage to the security, defence or international relations of the Commonwealth.

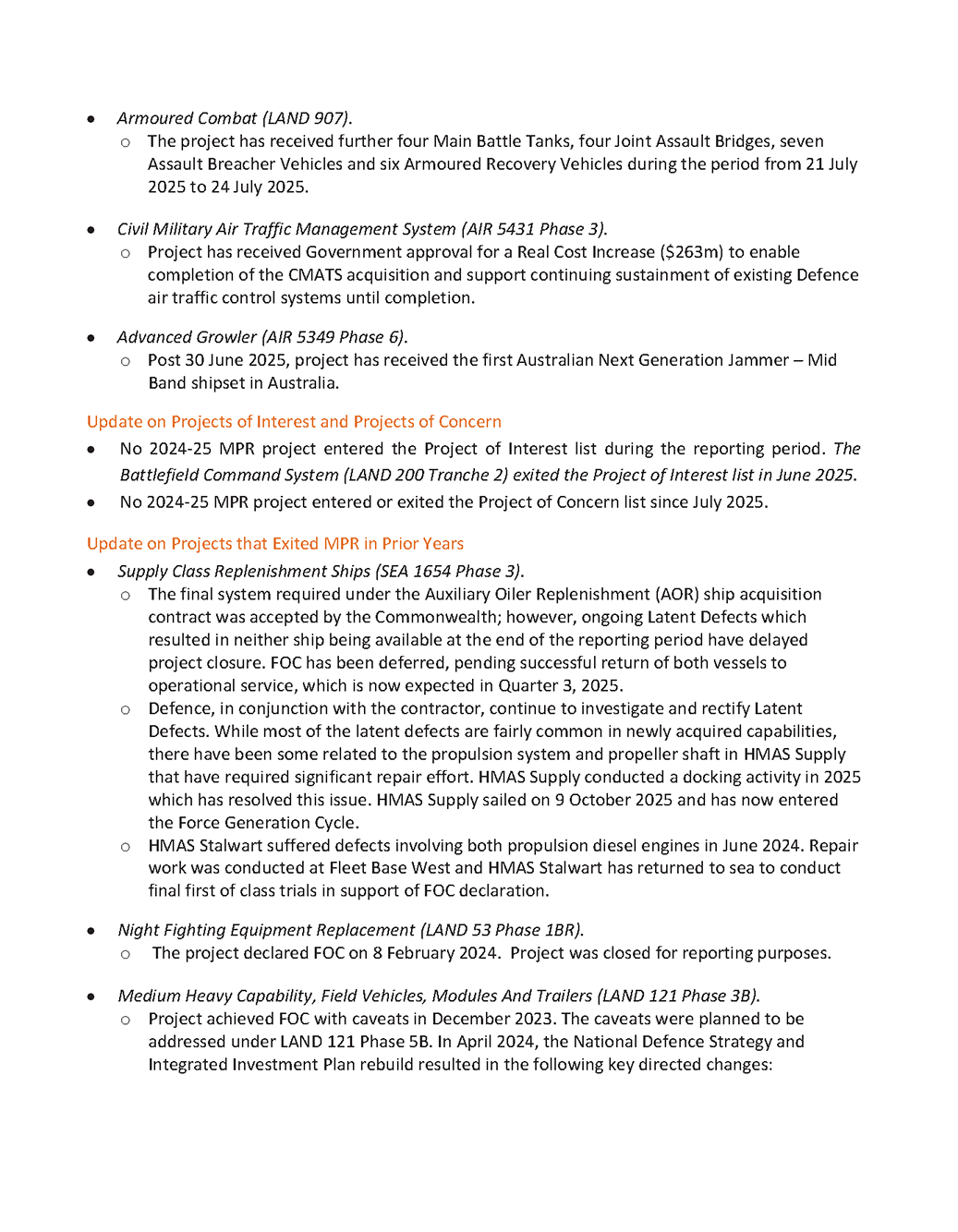

Statement by the Secretary of Defence

2.11 The Statement by the Secretary of Defence (Part 3 of this report) was signed on 8 December 2025. The Secretary’s statement provides his opinion that the PDSSs for the 21 major acquisition projects, which form part of the MPR ‘comply in all material respects with the Guidelines and reflect the status of the projects as at 30 June 2025’.

2.12 The Secretary’s statement notes the significant subsequent project events that occurred post-30 June 2025 as well an update on Projects of Interest and Projects of Concern. This also outlines the security classification review on the material presented in the PDSSs to ensure only unclassified information is published and anything that has been withheld was marked in the PDSSs as NFP or delayed.

Not for publication (NFP) information by Defence

The amount of information marked as NFP in the PDSS has significantly increased from 2021–22 to 2024–25, reducing the ANAO’s capacity to publish longitudinal analysis.

2.13 The 2024–25 MPR Guidelines sets out the information to be included in an unclassified manner by Defence in its PDSSs, including forecast dates and capability related information. The 2024–25 Guidelines also state that:

Defence is responsible for ensuring that information of a classified nature is made available to the ANAO for review, as it relates to the data contained within the PDSSs. Defence will provide data for inclusion in the final MPR in a way that allows for unclassified publication. Defence will provide advice to the ANAO on the classification of information in individual PDSSs and the aggregated security classification of information contained across all PDSSs.

2.14 Defence marks information as NFP in the PDSSs where it has assessed that some details, both with respect to independent projects and in the aggregate, would or could reasonably be expected to cause damage to security, defence or international relations to the Commonwealth without sanitisation of the data. While not disclosing information in this report, Defence has provided all information necessary to the ANAO to conduct its review, as required by the 2024–25 MPR Guidelines.

2.15 NFP information is determined through representations made by the Vice Chief of the Defence Force (VCDF) to the Secretary, advising the non-disclosure of selected information for publication after performing a security review over the PDSSs. In the 2024–25 MPR, 19 of the 21 projects included information marked as NFP, for example the non-disclosure of FOC dates, and therefore this information has not been disclosed in the published PDSSs. The full list of the PDSSs and the respective sections, which have been marked as NFP by Defence is in the Auditor-General’s Independent Assurance Report in Part 3 of this report.

2.16 This application of NFP has led to four successive Emphases of Matter in the Auditor-General’s Independent Assurance Reports (2021–22 to 2024–25). These draw attention to the non-disclosure of certain information by Defence in its reporting on projects, including project-level capability milestones and forecast delivery dates. 19 The number of projects in prior years containing non-disclosures were 20 in 2023–24; 12 in 2022–23; and four in 2021–22. The change from 20 projects in 2023–24 containing non-disclosures, to 19 projects in 2024–25, is in relation to SEA3036 Phase 1 Pacific Patrol Boat Replacement where the prior year non-disclosures were removed.20 The impact of non-disclosure has reduced the level of transparency to the Parliament and stakeholders.

2.17 The issue of transparency was raised in two reports by the JCPAA – Report 503: Inquiry into the Defence Major Projects Report 2020–21 and 2021–22 and Procurement of Hunter Class Frigates21 and Report 507—Defence 2022–23 Major Projects Report22 relating to its annual inquiries on the MPR. This issue remains outstanding and was also discussed at the November 2025 JCPAA inquiry into the 2023–24 MPR (see paragraphs 1.27 to 1.28).

2.18 The level of information subject to NFP has led to the ANAO’s inability to provide complete schedule and project performance analysis since it was last published in the 2020–21 MPR. This has historically involved both in-year analysis (across the current MPR projects) and longitudinal analysis (across all projects included in the MPR over time). Such information is now provided in aggregate or in summarised form to not identify the individual impacted projects.

Minimum Viable Capability

Minimum viable capability is a new milestone introduced by Defence in 2023 and has been applied to one project in the 2024–25 MPR.

2.19 Following the Defence Strategic Review 2023, Defence introduced the term Minimum Viable Capability (MVC) as an acquisition milestone. The 2024 National Defence Strategy23 states that:

A minimum viable capability is a capability that can be introduced into service successfully, sustained effectively and achieve the directed effect in the required time. It is underpinned by minimum viable products, which achieve or enable the lowest acceptable mission performance in the required time. This approach retains a focus on value for money, but places greater emphasis on speed to acquisition.

2.20 MVC is designed to deliver capabilities faster, more flexibly, and with greater responsiveness to strategic priorities. In late 2025, Defence commenced development of a framework to support how MVC will be applied to projects in practice. On 29 September 2025, Defence advised the ANAO that since the concept was introduced in 2023 ‘it has become apparent that MVC involves a range of complex, inter-related processes’. Defence further advised that ‘IOC [Initial Operating Capability] and FOC remain the authoritative project delivery milestones for all capability projects and continue to serve as the primary metrics for assessing delivery of Defence materiel’.

2.21 In the 2024–25 MPR, Defence has applied MVC to one project — AIR6500 Integrated Air and Missile Defence Command and Control. Government second pass approval was based on an MVC milestone rather than the traditional IOC and FOC milestones. In the 2024–25 PDSS, Defence has yet to define an IOC or FOC date for this project. PDSS data pertaining to AIR6500 Integrated Air and Missile Defence Command and Control is not comparable with other projects that have a defined IOC and FOC and has therefore been excluded from analysis on schedule performance and materiel capability/scope delivery performance. The relevant tables or figures have accompanying notes identifying where this information has been excluded from the analysis. As this is the first year the project has been reported in the MPR, the impacts from the application of MVC as a milestone are unknown.

3. Results of the ANAO’s review

PDSS preparation and review process

In 2024–25, the overall quality of the PDSS preparation has improved from previous years.

3.1 Defence prepares Project Data Summary Sheets (PDSSs) for the 21 selected major projects in accordance with the 2024–25 MPR Guidelines, which are required to be presented fairly and are free from material misstatement, whether due to fraud or error. A quality PDSS preparation and review process by Defence reduces the risk of untimely and/or inaccurate reporting. This will reduce the incidence of multiple reviews by the ANAO for the same project to ensure the required standard, as set by the Joint Committee of Public Accounts and Audit (JCPAA) through the MPR Guidelines, has been met.

3.2 In 2024–25, Defence provided three versions (includes two drafts and a publication version) of the PDSSs for the ANAO’s review between May and October 2025. Early in the 2024–25 PDSS assessment process, the ANAO recognised the implementation of an improved quality assurance program by Defence and the development of key artefacts to support project teams in developing their PDSS. Quality issues identified in previous MPRs decreased significantly in the ANAO’s first review of all 21 PDSSs, with a decrease from 1,038 to 461 actions24 (44 per cent reduction) associated with the review in 2024–25 when compared with 2023–24. These improvements continued to be observed into the second review with a reduction of 38 per cent fewer actions.25

Project reporting improvements

3.3 Throughout the MPR series, the ANAO reviews coupled with the annual JCPAA inquiries into the report, have contributed to accountability and improved governance of Defence major projects, despite Defence’s recent increase in information marked as NFP. This includes but is not limited to:

  • expanded efforts to centralise and standardise risk reporting, including adopting the ‘Predict!’ enterprise risk tool;
  • enhanced compliance reviews to improve project governance;
  • automated reporting on budget estimates, actual expenditure, and contingency usage;
  • improved records management and reporting of Project of Concern (POC) and Project of Interest (POI) to Minister for Defence Industry;
  • established the Lessons Governance Board to assess project and enterprise strategic lessons;
  • reduced year on year liquidated damages;
  • introduced accountability for the development of Australian Industry Capability plans; and
  • developed automation of Defence processes to improve the quality of PDSS preparation.

Lesson learned section of PDSSs

In 2024–25, Defence improved its disclosure of lessons learned, which meant that the previous year’s qualification by the Auditor-General was resolved.

3.4 In the 2022–23 and 2023–24 MPRs, the Auditor-General’s Independent Assurance Report included a qualified conclusion due to insufficient audit evidence to determine whether Defence’s disclosures in Section 6 of the PDSSs, relating to lessons learned, was in accordance with the requirements of the MPR Guidelines.

3.5 The disclosures in section 6 of the 2024–25 PDSSs have been expanded from those in the 2023–24 MPR to clearly indicate lessons that are strategic in nature and those that are assessed as project level (non-strategic). This change was made to address both the prior year Auditor-General qualified conclusion and to bring forward implementation of recommendation 1 from the JCPAA Report 507.26

3.6 Defence has implemented a CASG MPR Lessons Board (chaired by a Senior Executive Service (SES) Band 2 official), which provides some assurance over the current year lessons disclosures in the PDSSs. Board minutes analysed also identified that remediation activities have commenced to address open lessons findings.

3.7 New manual controls have been implemented by the Defence project teams. These include review and sign off on lessons information by a SES Band 1 official, categorisation between strategic and project lessons, and documenting the decision process in selecting lessons for disclosure from those recorded in the Defence Lessons Repository.

3.8 In 2024–25, the Auditor-General has not issued a qualification over Defence’s disclosures in Section 6 of the PDSSs relating to lessons learned and has determined that the requirements of the MPR Guidelines have been met.

Defence acquisition governance

Defence utilises various governance and oversight mechanisms to support the management of acquisition projects.

3.9 Consistent with prior years, the ANAO considered Defence’s major project acquisition governance processes when planning and conducting the review for the 2024–25 MPR. While some of these processes are well established, others have not yet been fully implemented to achieve their intended impact. More detail can be found in Defence’s Part 2 of this report. Table 3.1 summarises each area that the ANAO observed and accompanying findings.

Table 3.1: ANAO analysis of Defence acquisition governance activities relating to the MPR

Defence governance arrangements

ANAO assessment

Independent Assurance Reviews (IARs)

IARs are a review process that assures the Defence Executive that projects meet approved objectives within scope, schedule, and budget, and are ready for the next stage. IARs are typically undertaken in the lead up to Investment Committee consideration before major project milestones.

During 2024–25:

  • ten of the 21 projects (2023–24: 18) had completed an IAR.
  • IARs were not completed for 11 projects.a

Materiel Acquisition Agreements (MAAs)

MAAs document the internal arrangements between CASG and the Defence Service Chiefs and confirm project requirements and approved activities. They draw on original approval documents, such as government decisions, and are reviewed as required to manage changes to capability, schedule, and cost with Defence contractors. MAAs also provide data for Defence business reporting systems. MAAs are monitored and reported monthly and must be established both before and after government approval for project funding.

During 2024–25, 15 of the 21 projects had an MAA that was approved between 2023 and 2025:

  • four were approved between 2021 and 2023b; and
  • two had an MAA that was approved prior to 2021.c

Projects of Concern (POC) and Projects of Interest (POI)

The POC process provides ministerial oversight to remediate underperforming projects through collaboration with senior Defence leadership and industry partners. The POI process is a Defence-led monitoring program to identify and address issues early to prevent an escalation to POC.

Table 3.2 below outlines the two MPR projects classified as POC (2023–24: 2) and the six MPR projects classified as POI (2023–24: 7).

Smart Buyer Framework

The Smart Buyer Framework is typically undertaken following a project’s entry to the IIP, or to support ongoing strategy development. It identifies key project strategy drivers, and appropriate procurement and contracting methodologies, prior to consideration by the Investment Committee at each decision point. Application of the framework supports Defence to deliver value for money while optimising capability outcomes.

Of the two projects entering the MPR in 2024–25 — LAND8113 Phase 1 Long Range Fires and AIR6500 Integrated Air and Missile Defence Command and Control — both applied the Smart Buyer framework.

Smart Buyer activity has also been conducted in 2024–25 for two MPR projects (SEA1180 Phase 1 Offshore Patrol Vessel and SEA9100 Phase 1 IE Logistics Support Helicopter).

Australian Industry Capability (AIC)

A program that aims to provide Australian businesses the opportunity to compete for Defence work based on merit, influence foreign prime contractors and original equipment manufacturers to deliver cost-effective support, and encourage investment in Australian industry. AIC schedules and plans should describe how a tenderer has engaged with Australian industry to deliver the required goods, works or services.

AIC schedules are required for materiel procurements valued between $4 million and $20 million. AIC plans are required for materiel procurements valued at $20 million or more.

Seven of the 21 projects (2023–24: 5) did not have AIC plans in place.d Examples of reasons provided in the PDSSs included:

  • the project has no contracted AIC plans for its US Government FMS or US Cooperative Program acquisitions;
  • the acquisition was a direct sole source procurement; and
  • the project has provisions to encourage competitive participation of Australian industry without the contractual obligations for AIC.

A further 10 projects had not published a public plan for one or more of their eligible contractors.

Note a: The following projects underwent IARs in 2024–25 however the reports were finalised in 2025–26: AIR6000 Phase 2A/2B Joint Strike Fighter; AIR7001 MQ-4C Triton; AIR555 MC-55A Peregrine; AIR5341 Phase 3 CMATS; and SEA3036 Phase 1 Pacific Patrol Boat Replacement.

Note b: The projects with most recent MAAs finalised between calendar years 2021 to 2023 were: LAND400 Phase 2 Combat Reconnaissance Vehicles; AIR555 MC-55A Peregrine; LAND907 Armoured Combat; SEA1439 Phase 5B2 Collins Comms and EW.

Note c: Projects with most recent MAAs finalised prior to 2021: SEA1180 Phase 1 Offshore Patrol Vessel and LAND121 Phase 4 Hawkei.

Note d: The projects that did not have an AIC plan were: AIR6000 Phase 2A/2B Joint Strike Fighter, AIR555 Phase 1 Peregrine, AIR7001 MQ-4C Triton, LAND4503 Phase 1 ARH Replacement, LAND8113 Phase 1 Long Range Fires, LAND200 Tranche 2 Battlefield Command System, and SEA9100 Phase 1 IE Logistics Support Helicopter.

Source: ANAO analysis of the 2024–25 PDSSs.

Projects of Concern and Projects of Interest

Of the 21 projects in the 2024–25 MPR, Defence had classified two as Projects of Concern (POC) and six as Projects of Interest (POI).

3.10 Defence considers placing an acquisition project on the POI or POC list when significant risks or issues, and/or breaches of project parameters have been identified through its internal reporting and/or oversight mechanisms.

  • The POC process intends to manage the remediation of underperforming projects. This process is led by the Minister for Defence Industry through joint collaboration with senior Defence officials and industry management, and the development of a plan to resolve issues.
  • The related POI process is where projects are monitored internally by Defence to ‘ensure issues are remediated and that the projects does not progress to a POC’.

3.11 As at 30 June 2025, as set out in Table 3.2, two MPR projects were classified as POC (2023–24: 2 — same projects) and seven projects were POI (2023–24: 7 — same projects).

Table 3.2: 2024–25 MPR Projects of Concern and Projects of Interest

Projects of Concern

AIR5431 Phase 3 CMATS

SEA1180 Phase 1 Offshore Patrol Vessel

Project of Interest

SEA5000 Hunter Class Frigates

AIR6000 Phase 2A/2B Joint Strike Fighter

LAND400 Phase 2 Combat Reconnaissance Vehicles

AIR555 Phase 1 Peregrine

LAND121 Phase 4 Hawkei

AIR2025 Phase 6 JORN Mid-Life Upgrade

LAND200 Tranche 2 Battlefield Command System

Note: AIR2025 Phase 6 JORN Mid-Life Upgrade exited the POI list in August 2024.

Source: Defence June 2025 Projects and Products of Interest and Concern.

Projects of Concern

3.12 AIR5431 Phase 3 CMATS was listed as a POC between August 2017 and May 2018 due to extended contract negotiations that delayed its formal commencement. After the contract was signed, AIR5431 Phase 3 CMATS was managed as a POI until October 2022, when it was reclassified as a POC. This decision was based on the project facing significant schedule, technical and cost challenges. Schedule delays are discussed further from paragraph 4.16. The anticipated exit date of AIR5431 Phase 3 CMATS from the POC list is mid-2027.

3.13 SEA1180 Phase 1 Offshore Patrol Vessel was listed as a POC on 20 October 2023 due to delays affecting both ship construction and the associated support system. On 20 February 2024, the Australian Government announced that SEA1180 Phase 1 Offshore Patrol Vessel would be reduced from 12 to six vessels. Defence and the contractor have committed to jointly addressing the project’s challenges through a POC remediation plan.

Projects of Interest

3.14 The seven MPR projects that were listed as POIs are discussed below.

  • SEA5000 Hunter Class Frigates — A POI since March 2020 due to significant challenges in schedule, technical complexity, workforce availability and cost. Despite progress (including the transition to the construction phase for the first three ships in June 2024) the project continues to face risks related to design maturity and integration.
  • AIR6000 Phase 2A/2B Joint Strike Fighter — a POI since June 2017 due to its strategic importance and early concerns about achieving IOC. Although IOC was declared on schedule in December 2020, the project remains under scrutiny due to its scale and complexity. A case study on the history of this project since entering the MPR in 2011 is presented at paragraph 3.38, noting that the 2024–25 MPR is the last year the project will be reported.
  • LAND400 Phase 2 Combat Reconnaissance Vehicles — added to the POI list in June 2024 due to the complexity of delivering both LAND400 Phase 2 and the Boxer Heavy Weapon Carrier Export project. Persistent schedule pressures continue to affect the achievement of the FOC milestone.
  • AIR555 Phase 1 Peregrine — a POI since September 2023 due to delays in the aircraft flight test program.
  • LAND121 Phase 4 Hawkei — a POI from December 2018 to May 2021 and from July 2023, primarily due to unresolved brake issues and operating restrictions across the ADF fleet.
  • AIR2025 Phase 6 JORN Mid-Life Upgrade — a POI since September 2019 due to unrecoverable delays in engineering design milestones, which has disrupted the original schedule for Initial and Final Materiel Release.
  • LAND200 Tranche 2 Battlefield Command System — since September 2018 due to issues associated with vehicle integration and realisation of risks resulting in the request to access contingency funding.

3.15 From June 2023, the Minister for Defence Industry requested monthly POC and POI reporting. Monthly reports and the Quarterly Performance Reports are reviewed by the ANAO as part of the PDSS reviews to validate the POC and POI in the MPR.

Project budget and expenditure

Of the 21 MPR projects, one stated that there was insufficient budget for the project to be completed against the agreed scope.

Project financial assurance statement

3.16 The 2011–12 MPR introduced the project financial assurance statement, which is the project’s assessment of its budget sufficiency for the delivery of agreed capability/scope. The contingency statement has been included since the 2013–14 MPR. It is a description of the use of contingency funding to mitigate project risks during the reporting period. These statements aim to provide transparency over the project’s financial status.

3.17 A project’s total approved budget comprises of:

  • allocated budget, which covers the project’s approved activities set out in the MAA; and
  • contingency budget, which is set aside for the eventuality of risks occurring and includes unforeseen work that arises within the delivery of the planned scope of work.27

3.18 As at 30 June 2025, 20 of the 21 MPR projects stated that sufficient budget remained for the projects to be completed against the agreed scope. The exception was AIR5431 Phase 3 CMATS, which stated insufficient funds due to the extended project delivery duration, potential regulatory or compliance contract changes, rework of customer furnished services and ongoing external workforce requirements. The statement is restricted to Defence’s current financial contractual obligations for the project and current known risks and estimated future expenditure.

Caveats, deficiencies and contingencies

No caveats or deficiencies were declared and four projects either applied for or spent contingency funds.

3.19 In the PDSSs, Defence is required to declare any significant capability milestones with caveats or deficiencies, as well as the use of contingency funds.28

3.20 No caveats or deficiencies were declared in the 2024–25 MPR relating to the 21 projects.29

3.21 In 2024–25, four projects either spent or applied for contingency funds to manage project risks (2023–24: three).

  • AIR5431 Phase 3 CMATS — for progressing the Air Traffic Management Capability Assurance Program under existing support arrangements for the Australian Defence Air Traffic System, and a CMATS remediation activity.
  • LAND19 Phase 7B SRGB Air Defence — applied for contingency as a result of delays relating to the COVID-19 pandemic. Defence used quarantined funds for the Advanced Medium Range Air-to-Air Missile Foreign Military Sale case for the treatment of these risks.
  • SEA3036 Phase 1 Pacific Patrol Boat Replacement — primarily for engineering modifications, using part of the contingency funding applied for in 2022–23.
  • AIR6500 Integrated Air and Missile Defence Command and Control — spent contingency associated with the application made in 2023–24 for price escalation.

3.22 In 2024–25, all 21 MPR projects complied with Defence’s financial policy relating to contingency funding. Defence policy states that a project’s contingency is to provide funding for cost, schedule and technical uncertainties that may materialise over the life of a project. The policy requires the project manager to maintain a project contingency log, which is intended to support management’s control of project contingency and facilitate reporting on its use. The use of contingency funding is dependent on the occurrence of a contingency risk event and contingency cannot be used to pay for activities, which could increase the scope of the capability project.

3.23 Two compliance issues emerged during the 2024–25 MPR review of project contingency logs.

  • Lack of clarity of the relationship between contingency allocation and identified risks, an issue highlighted in previous MPRs.30 Two projects (LAND4503 Phase 1 Apache Attack Helicopter and SEA1448 Phase 4B ANZAC Air Search Radar Replacement) did not explicitly align the contingency log with the risk log to ensure that the expected cost impact of risks is maintained effectively.
  • Insufficient timely review and updates of the contingency logs. A total of nine projects provided contingency logs that were not updated including: more than six months (seven projects)31; or more than 12 months (AIR6000 Phase 2A/2B Joint Strike Fighter); and one contingency log was not dated (AIR555 MC-55A Peregrine).

3.24 Table 3.3 sets out the projects that applied for or utilised contingency funds and Figure 3.1 provides a summary of the key reasons.

Table 3.3: Projects that either spent or applied for contingency funds between 2020–21 and 2024–25

2020–21

2021–22

2022–23

2023–24

2024–25

AIR9000 Phase 2/4/6 MRH90 Helicopters

AIR9000 Phase 2/4/6 MRH90 Helicopters

AIR9000 Phase 2/4/6 MRH90 Helicopters

AIR5431 Phase 3 CMATS

AIR5431 Phase 3 CMATS

JNT2072 Phase 2B Battlespace Communications Systems

SEA1180 Phase 1 OPV

AIR5431 Phase 3 CMATS

SEA3036 Phase 1 Pacific Patrol Boat Replacement

SEA3036 Phase 1 Pacific Patrol Boat Replacement

LAND19 Phase 7B SRGB Air Defence

LAND19 Phase 7B SRGB Air Defence

LAND19 Phase 7B SRGB Air Defence

LAND19 Phase 7B SRGB Air Defence

JNT2072 Phase 2B Battlespace Communications Systems

AIR6500 IAMD Command and Control

Source: ANAO analysis of the 2020–21 to 2024–25 PDSSs.

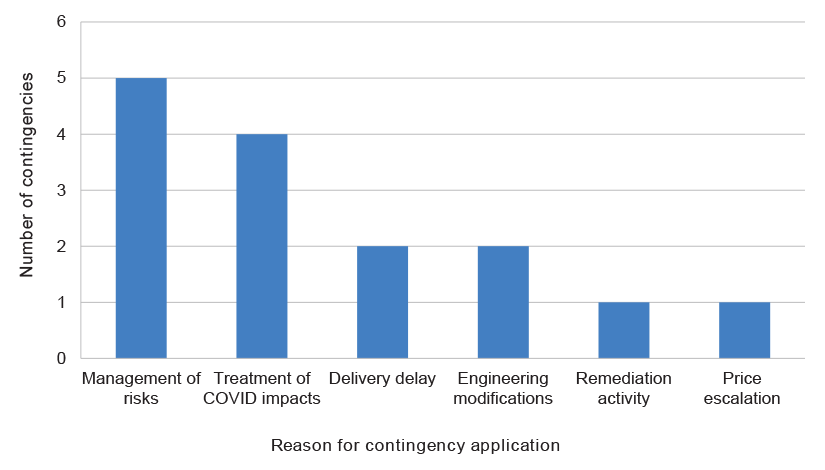

Figure 3.1: Reasons for contingency application between 2020–21 and 2024–25

Figure 3.1: Reasons for contingency application between 2020–21 and 2024–25

Source: ANAO analysis of the 2020–21 to 2024–25 PDSSs.

Risk management

In 2024–25, all PDSSs contained risks and issues that Defence rated as ‘high’ or ‘very high’, with the number varying depending on factors including complexity or delivery stage of the project.

3.25 Defence standardised the use of Predict! as its corporate risk management system in May 2020.32 The ANAO’s review in 2024–25 identified that:

  • all 21 projects offices utilised Predict! (no change from the 2023–24 MPR); and
  • one project (AIR5431 Phase 3 CMATS) used Predict! and a bespoke SharePoint tool jointly with Airservices Australia, as Airservices Australia does not use Predict!.33

3.26 The 2024–25 PDSSs report both major risks and issues (those rated as ‘high’ and ‘very high’). Risks represent potential events that may impact project objectives. Issues are ‘high’ or ‘very high’ risks that have been realised or issues that have arisen that require immediate management action. The number of major risks and issues vary across the 21 MPR projects, reflecting factors such as the stage of the project and the complexity of the acquisition.

3.27 Figure 3.2 outlines the number of major risks and issues for each project in 2024–25. AIR5431 Phase 3 CMATS had the highest number of major risks (12) and is managing four issues, which is consistent with the POC status of the project. LAND907 Armoured Combat did not report any major risks or issues as it had reached the late stage of the project.

Figure 3.2: Total in-year reported risks and issues by project 2024–25a b c

Figure 3.2: Total in-year reported risks and issues by project 2024–25

Note a: Major project risks include risks and emergent risks reported in Section 5.1 and 5.2 of the PDSSs.

Note b: One project (SEA9100 IE Logistics Helicopter) included an issue marked as ‘not for publication’.

Note c: JORN Mid-Life Upgrade exited the POI list in August 2024.

Source: ANAO analysis of the 2024–25 PDSSs.

3.28 Defence reported a total of 74 risks and 34 issues across the 21 PDSSs. This represents a total of 108 combined risks and issues, compared with a total of 71 in 2023–24. Analysis of the 2024–25 risks and issues is set out below.

  • 19 risks (26 per cent) and seven issues (21 per cent) were in relation to the two POC projects (SEA1180 Phase 1 Offshore Patrol Vessels and AIR5431 Phase 3 CMATS).
  • 28 risks and 15 issues were in relation to the six POI projects (SEA5000 Hunter Class Frigates, AIR6000 Phase 2A/2B Joint Strike Fighter, LAND400 Phase 2 Combat Reconnaissance Vehicles, AIR555 MC-55A Peregrine, LAND121 Phase 4 Hawkei and AIR2025 Phase 6 JORN Mid-Life Upgrade).
  • 27 risks (36 per cent of all risks) and 23 issues (68 per cent of all issues) are reported as downgraded or retired and will be removed from the subsequent MPR.

3.29 For the 21 projects in the 2024–25 MPR, the number of major project risks and issues has varied across the three domains of LAND, SEA and AIR, see Figure 3.3.

Figure 3.3: Total reported risks and issues by domaina

Figure 3.3: Total reported risks and issues by domain

Note a: One project (SEA9100 IE Logistics Helicopter) included an issue marked as ‘not for publication’.

Source: ANAO analysis of the 2024–25 PDSSs.

3.30 Projects within the AIR domain have the highest total number of major risks at 36 (49 per cent). Twelve of the major risks are in relation to AIR5431 Phase 3 CMATS. Under the OneSKY Australia program, Airservices Australia is the lead agency for the joint procurement of CMATS and Airservices Australia has entered into contracts for the acquisition and support of CMATS on behalf of Air Services Australia and Defence (see paragraph 1.22).

3.31 There were 18 major risks (24 per cent) for the SEA domain, and 20 (27 per cent) for the LAND domain. The AIR domain managed nine major issues, the lowest compared to the LAND domain (11) and the SEA domain (14).

3.32 Defence’s risk management has been a focus of the MPR since its inception in 2008–09. Risk management has also been reviewed by the JCPAA, most recently in its Inquiry into the Defence Major Projects Report 2020–21 and 2021–22 and Procurement of Hunter Class Frigates. In its June 2024 report on the inquiry, the Committee observed that:

… there are still inconsistencies in Defence’s risk management practices, although improvements have been made, and this still needs to be addressed going forward.34

3.33 Paragraph 3.3 outlines Defence’s efforts to centralise key governance processes, including risk management, however, the ANAO identified weakness in controls within Predict! in the 2022–23 MPR.35 These have not yet been addressed by Defence and continue to impact the effectiveness of the system and data quality. In the 2024–25 MPR, the ANAO identified the following issues.

  • Variable compliance with corporate guidance. All 21 projects had an approved Risk Management Plan, however, three projects36 (AIR555 MC–55A Peregrine, AIR7001 MQ–4C Triton and SEA9100 Phase 1 IE Logistics Support Helicopter) were unable to demonstrate a review of their risk management plan as required by Defence policy.
  • Lack of visibility of risks and issues when a project is transitioning to sustainment.
  • Risks and issues logs are not reviewed and updated in a timely manner to ensure accurate, complete and up-to-date record of risks and issues.
  • Lack of quality control resulting in inconsistent approaches in the recording of issues within Predict!.

Defence acquisition categories

3.34 Defence categorises projects into four acquisition categories (ACAT) of descending level of complexity, to aid in the management of risk:

  • ACAT I projects are Defence’s most strategically significant major capital acquisitions;
  • ACAT II projects are strategically significant major capital acquisitions;
  • ACAT III projects are major or minor capital acquisitions of moderate strategic significance; and
  • ACAT IV projects are major or minor capital acquisitions of lower strategic significance.

3.35 The number of ACAT I projects reported in the MPR has decreased over the past five years, and reporting of ACAT II and ACAT III projects has increased (see Table 3.4).

Table 3.4: ACAT ratings of projects between 2020–21 and 2024–25

Year

ACAT I

ACAT II

ACAT III

ACAT IV

Total projects

2020–21

10

11

0

0

21

2021–22

10

11

0

0

21

2022–23

10

10

0

0

20

2023–24

8

12

1

0

21

2024–25

7

13

1

0

21

Source: ANAO analysis of the 2024–25 PDSSs and previously published Defence PDSSs.

Use of different acquisition approaches

A combination of different acquisition approaches may be used simultaneously, or at different points, during a project’s delivery lifecycle.

3.36 The suite of current and historical PDSSs indicates that Defence has primarily acquired the major projects using the following approaches.

  • Foreign Military Sales (FMS) — this is where the US Government and a foreign government enter an agreement called a Letter of Offer and Acceptance, in this case the foreign government is Australia. FMS cases tend to be acquisitions of mature platforms from existing production lines, for example LAND4503 Apache Attack Helicopter. There are a total of five projects using the FMS approach (see Table 1.1).
  • Government-to-government (GtG) agreements — this is where the Australian Government and a foreign government enter into an arrangement, not an FMS acquisition, and is established through a Memorandum of Understanding, including co-operative agreements. These procurements are typically for developmental programs where Australia and another country will collaborate on the development of a platform, for example AIR6000 Phase 2A/2B Joint Strike Fighter. There are a total of three projects using the GtG approach (see Table 1.1).
  • Other — these approaches typically involve direct contracts with commercial suppliers for developmental or domestic acquisitions. There are a total of 13 projects using the ‘other’ approach (see Table 1.1).

3.37 A project may have multiple approaches to acquiring different aspects of its scope. For example, AIR5349 Phase 6 Advanced Growler is being delivered through a GtG, FMS and a contract with a supplier. For the purposes of the analysis of this report, the ANAO has categorised projects based on their lead contract or primary acquisition arrangement.

3.38 Case study 1 on AIR6000 Phase 2A/2B Joint Strike Fighter provides an overview of project performance since it was first reviewed in the 2010–11 MPR. This project has been the subject of the MPR review since 2008, is a GtG delivery and rated as an ACAT I (very high level of complexity) project by Defence. Overall, this project was delivered within budget and with no change to the total capability delivered, noting the project’s overall ‘green’ rating for scope delivery performance since 2016. The final materiel release date was 17 months later than planned, primarily due to software testing.

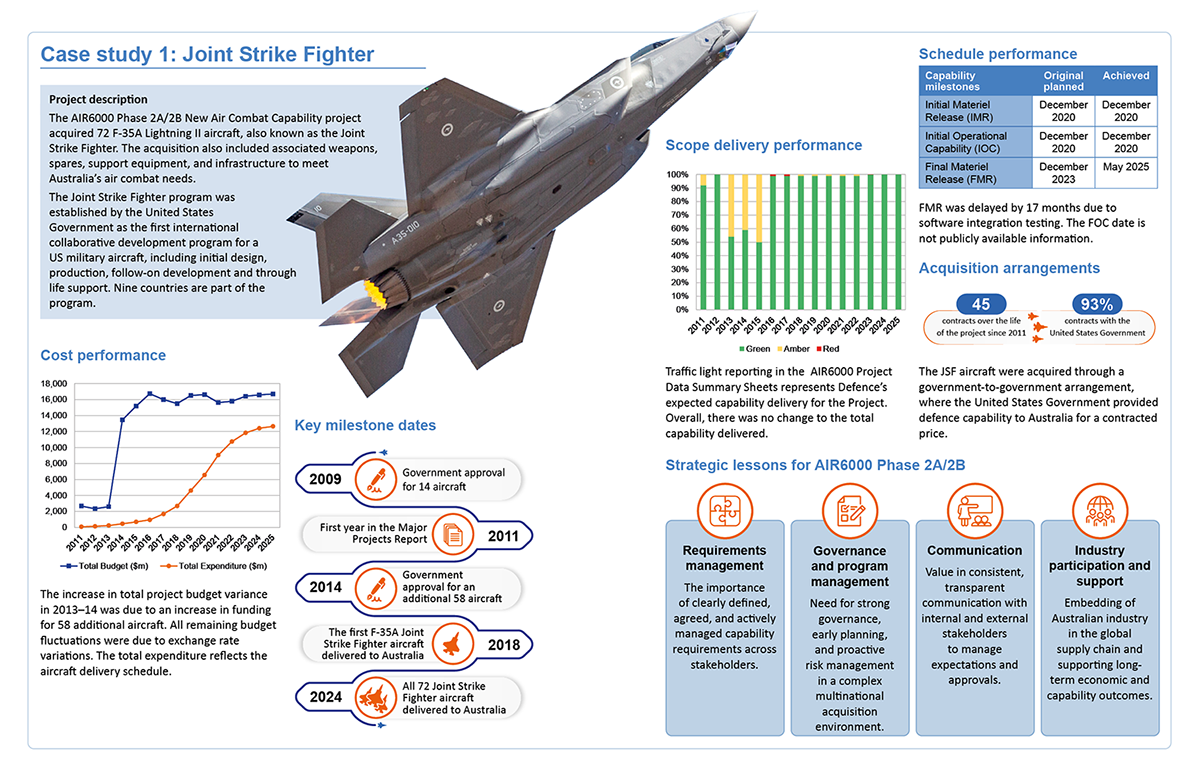

Case study 1: Joint Strike Fighter

Case study 1: Joint Strike Fighter

4. Project performance analysis

4.1 The ANAO has undertaken an in-year analysis of the 21 PDSSs to review project performance in addition to its limited assurance review. The three performance elements analysed were cost, schedule and the delivery of capability/scope, as described in Figure 4.1. The ANAO has presented information in aggregate, average and median measures to analyse the three performance elements, selecting the most appropriate approach for each. This flexible methodology was necessary because a standardised format could not be adopted without risking unintended disclosure of not for publication (NFP) information contained in the Project Data Summary Sheets (PDSSs), which are prepared by Defence.

Figure 4.1: Project performance elements

Figure 4.1: Project performance elements

Source: ANAO analysis of the 2024–25 MPR Guidelines.

Cost performance

The total expenditure for AIR domain projects is approximately double that of SEA and LAND domains.

4.2 Analysis of the cost performance of the 21 projects includes: changes in budget since government second pass approval; total project expenditure by project and by domain; and forecast expenditure compared with actual expenditure.

4.3 Budget variations can include transfers of budget within Defence projects, additional funding from government approvals for scope changes, real cost increases, or administrative decisions. Budget variations since initial Second Pass Approval total $37,254.4 million. Of this, SEA5000 Hunter Class Frigate and AIR6000 Phase 2A/2B Joint Strike Fighter account for 80.9 per cent ($30,134.7 million) predominantly due to government approved changes in scope (an increase in 58 aircraft for AIR6000 and approval to commence construction of one to three ships for SEA5000) and exchange variations. Across all projects exchange variations contributes approximately $5,512.9 million. Table 4.1 sets out all budget variations for each project in the MPR as at 30 June 2025.

Table 4.1: Budget variations post government initial second pass approval by variation type as at 30 June 2025a

Project

Budget at Second Pass Approval ($m)b

Variation type

Explanation of variation

Year/s of variation

Total variation ($m)

SEA5000 Hunter Class Frigates

6,183.9

Budget transfer/Government Second Pass Approval June 2024 (Batch 1 Construction)

Funding transfers between CASG and other areas of Defence, and approval to commence construction of ships.

2019–20

2021–22

2022–23

2023–24

19,661.6

LAND400 Phase 2 Combat Reconnaissance Vehicles

5,762.7

Budget Transfer

Funding transfer to enable Directorate of Land Training Capability to facilitate delivery of land simulation.

2024–25

(4.5)

AIR6000 Phase 2A/2B Joint Strike Fighter

2,751.6

(Stage 1)

Scope increase/Budgetary Adjustments/Transfer

Government approval for 58 additional aircraft, and upgrades to air base facilities.

2013–14

2017–18

2022–23

10,473.1

AIR5349 Phase 6 Advanced Growler

271.1

Scope Increase/Transfer

Next generation Jammer development and acquisition of aircraft upgrades, missiles and electronic warfare range upgrades and associated sustainment costs.

Approval for facilities, offset by transfers between CASG and other areas of Defence.

2019–20

2021–22

2022–23

2,878.4

AIR7001 MQ-4C Triton

924.9

Scope increase/Budget Transfer/Real cost decrease/Budgetary adjustment

Three additional aircraft across multiple approvals, and approval for initial sustainment funding.

Minor transfers and budgetary adjustment.

2017–18

2018–19

2019–20

2020–21

2021–22

2022–23

2023–24

2024–25

1,400.2

AIR555 MC-55A Peregrine

2,166.3

Budgetary adjustment

Minor transfers and corrections.

2018–19

2021–22

2022–23

2023–24

2024–25

56.8

AIR2025 Phase 6 JORN Mid-Life Upgrade

1,117.9

Scope increase/Budget Transfer/Budgetary adjustment

Budgetary adjustment for High Power Amplifier Replacement Project.

Other minor adjustments, transfers and scope increases.

2020–21

2021–22

2022–23

2023–24

2024–25

132.6

LAND8113 Phase 1 Long Range Fires

658.6

Scope Increase/Budgetary Adjustment

Budgetary adjustment for estate components, and additional weapons systems.

2023–24

2024–25

1,624.2

SEA9100 Phase 1 IE Logistics Support Helicopter

1,460.2

Budget Transfer

Budget transfer from AIR9000 Phase 8.

2024–25

337.1

LAND19 Phase 7B SRGB Air Defence

1,274.3

Budget Transfer

Defence Science and Technology Group project closures and the transfer to Military Equipment Acquisition Projects.

2024–25

0.6

AIR5431 Phase 3 CMATS

731.4

Real Cost Increase/ Budgetary Adjustment/Budget Transfer

Real cost increase and transfer of Air Force budget to the project, offset by minor transfers.

2017–18

2021–22

2022–23

274.9

SEA1439 Phase 5B2 Collins Comms and EW

247.7 (Stage 1)

Scope Increase/Budgetary Adjustment

Additional communications capability and minor budgetary adjustment.

2016–17

2020–21

353.9

SEA3036 Phase 1 Pacific Patrol Boat Replacement

504.5

Transfer

Transfer of funding to NSSG for acquisition of three vessels.

2023–24

2024–25

65.5

Note a: Some projects have multiple government second pass approvals. This table reports on variations since the first/initial Second Pass Approval. Projects that have had no Real Variations to their budget do not appear in this table. They were: Apache Attack Helicopter, Offshore Patrol Vessel, Armoured Combat, Hawkei, IAMD Command and Control, Battlefield Command System, Maritime Comms and ANZAC Air Search Radar Replacement. For a definition of ‘Real Variations’ see the 2024–25 MPR Guidelines in Part 4 of this report.

Note b: Budget at Second Pass Approval column is based off the initial Second Pass Approval of projects at the point of provision of the authority for a project to begin acquisition.

Source: ANAO analysis of 2024–25 PDSSs.

4.4 Real variations37 are a subset of all budget variations and primarily reflect changes to project scope, transfers between projects for approved equipment/capability, and budgetary adjustments such as administrative savings decisions. The two projects with the most significant real variations as at 30 June 2025 were:

  • SEA5000 Hunter Class Frigate — $19,661.6 million for government second pass approval of construction of the first of three ships; and
  • AIR6000 Phase 2A/2B Joint Strike Fighter — $10,473.1 million for Stage 2 government second pass approval of 58 additional aircraft.

4.5 The four projects with government approved scope increases valued at over $500 million ($0.5 billion) are set out in Figure 4.2

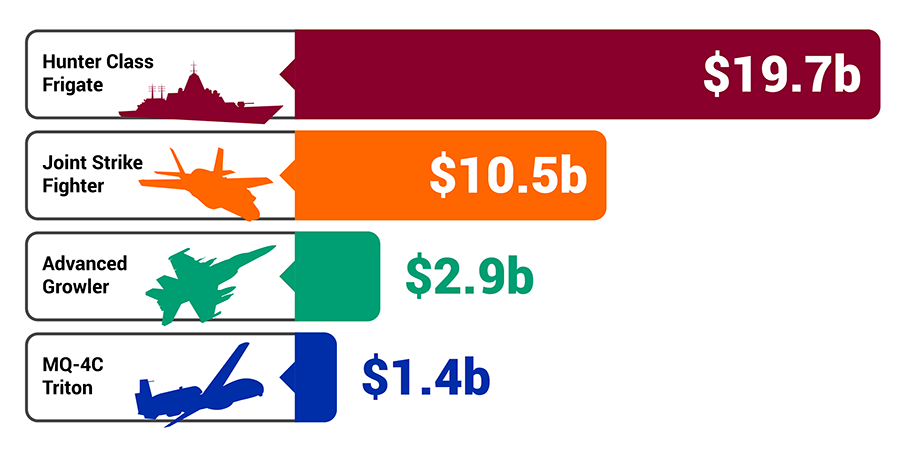

Figure 4.2: Projects with government approved scope increases over $0.5 billiona b c

Figure 4.2: Projects with government approved scope increases over $0.5 billion

Note a: Hunter Class Frigate – 2023–24: Second Pass Approval (Batch 1 Production); Joint Strike Fighter – 2013–14: 58 additional aircraft at Stage 2 Second Pass Approval; Advanced Growler - 2019–20: Government Interim Pass Approval ($0.3b); and 2022–23: Second Pass Approval for Tranche 1 ($2.6b); MQ-4C Triton - 2019–20: Second Pass Approvals Tranche 2 and 3 ($0.9b); 2020–21: Second Pass Approval Tranche 4 ($0.2b); and 2022–23: Subsequent Government Approval ($0.3b).

Note b: There are other scope increases across PDSSs that do not meet the $0.5b threshold.

Note c: For projects with multiple Second Pass Approval, this chart shows variations from the initial approval.

Source: ANAO analysis of the 2024–25 PDSSs and previously published Defence PDSSs.

4.6 Exchange variations38 since government second pass approval across all 21 projects total $5,512.9 million. AIR6000 Phase 2A/2B Joint Strike Fighter accounts for 56.8 per cent ($3,132.4 million) of the total amount.

4.7 Figure 4.3 provides the total expenditure of the 21 MPR projects up to 30 June 2025, representing a total of $37,355.9 million. It also shows each project’s in-year expenditure for 2024–25 which is an indicator of milestone delivery and payments.

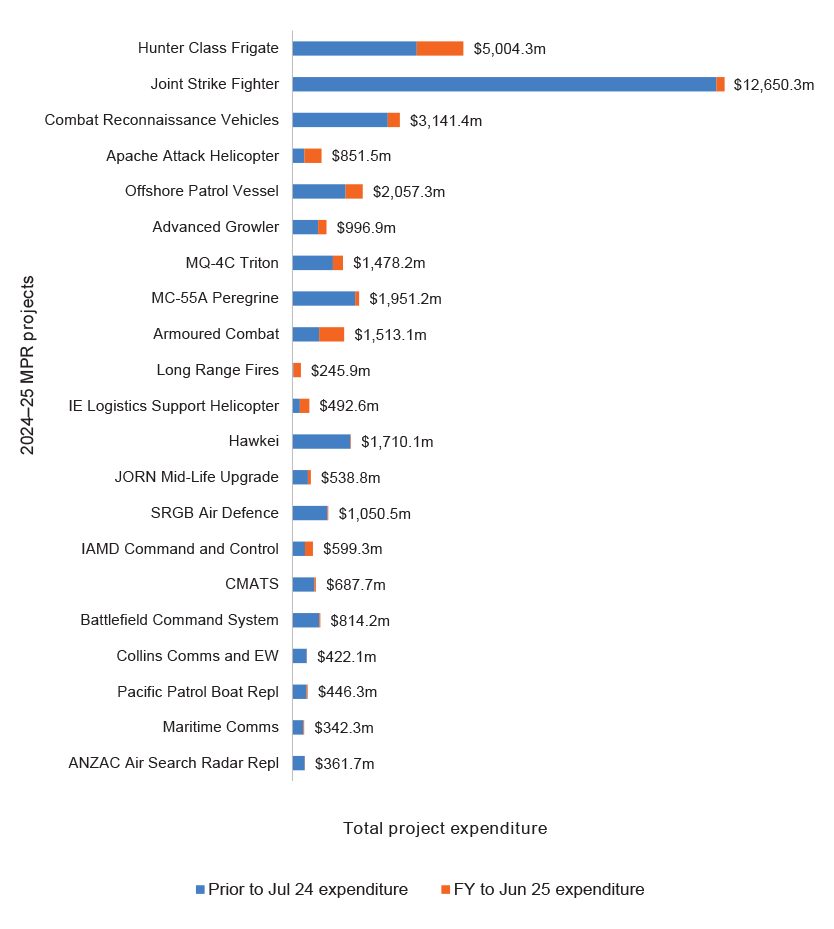

Figure 4.3: Total project expenditure as at 30 June 2025 ($m)

Figure 4.3: Total project expenditure as at 30 June 2025 ($m)

Source: ANAO analysis of the 2024–25 PDSSs.

4.8 Figure 4.4 summarises the total project expenditure by domain, for the current year and for all years prior to July 2024, as reported in the 2024–25 PDSSs.

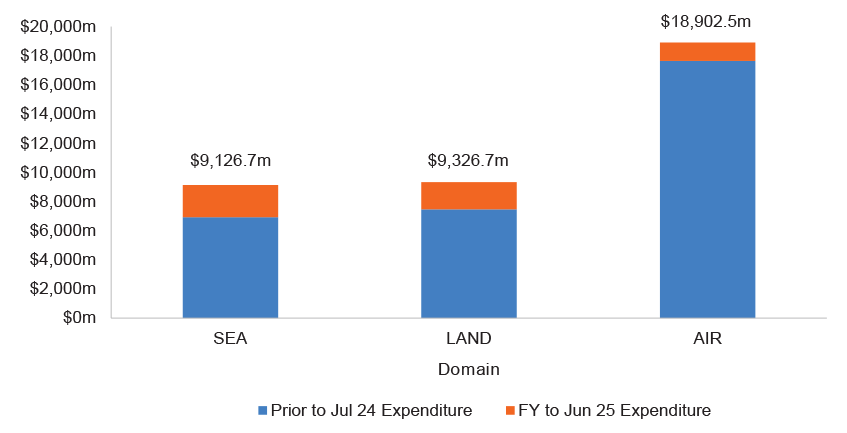

Figure 4.4: Total project expenditure by domain as at 30 June 2025 ($m)

Figure 4.4: Total project expenditure by domain as at 30 June 2025 ($m)

Source: ANAO analysis of the 2024–25 PDSSs.

4.9 The total expenditure for AIR domain projects is approximately double that of each of the two other domains (SEA and LAND), accounting for 51 per cent of the total expenditure for the 21 projects. This is largely driven by AIR6000 Phase 2A/2B Joint Strike Fighter, which has $16.7 billion total approved budget (including $10.5 billion due to scope increase, see Figure 4.2). This contributed to 67 per cent of the total expenditure accrued by the AIR domain and 34 per cent of the total expenditure across all projects.

4.10 The SEA domain accounts for 24 per cent and the LAND domain accounts for 25 per cent of total expenditure accrued across all projects.

4.11 Accurately forecasting and managing budget expenditure is a key element in the management of acquisition projects. The MPR Guidelines require projects to disclose in their PDSSs their forecasts and budget estimates. The Portfolio Budget Statement (PBS) process details the proposed allocation of public resources to government outcomes, including estimated payments and receipts for individual entities. The PBS is tabled in the Parliament on Budget Night, the second Tuesday in May of each year. The Portfolio Additional Estimates Statements (PAES) process includes the government approved changes to the proposed allocation of resources since the Budget. PAES is tabled in the Parliament usually in mid-February each year.39

4.12 Figure 4.5 (value) and Figure 4.6 (percentage) show the accuracy of each project’s 2024–25 budget forecasts, by comparing the actual expenditure to these three key forecasts: budget approved through PBS in May 2024 (blue) and PAES in February 2025 (green), and the project’s in-year budget (orange). The length of the bars represents how much the project’s actual expenditure differs from these budget forecasts. The middle axis represents that an accurate expenditure to the forecast was achieved, with bars to the right-hand side indicating an overspend and those to the left-hand side indicating an underspend.

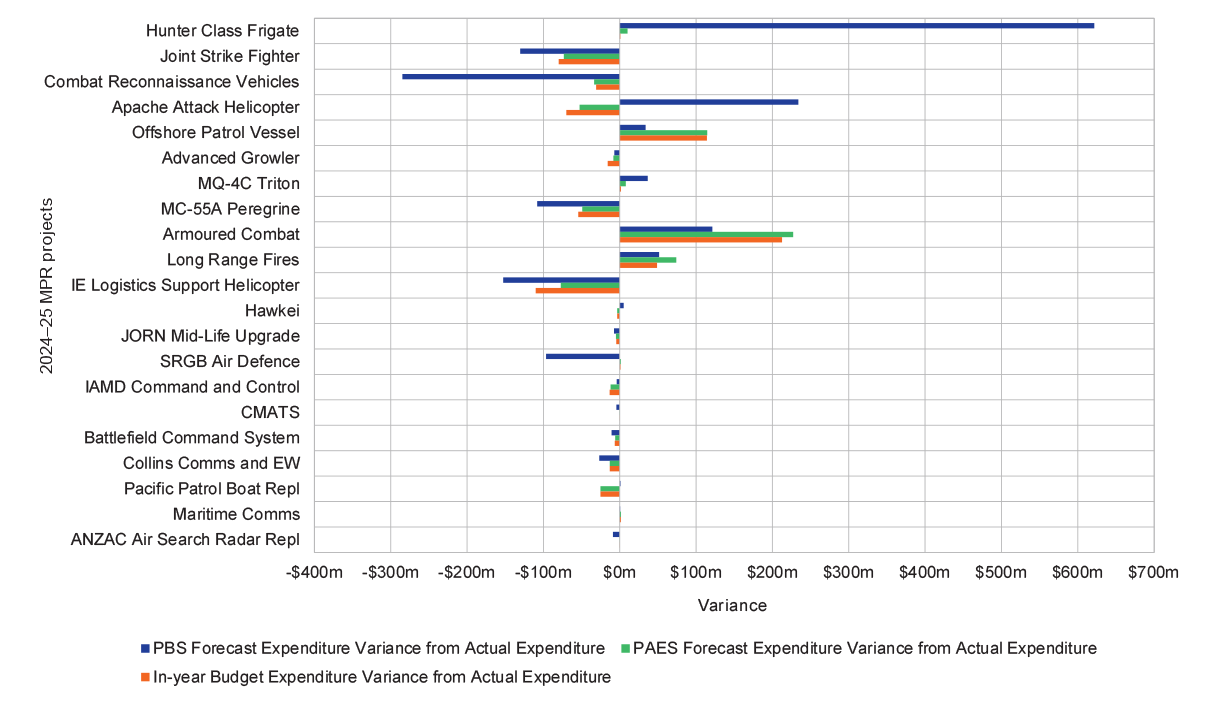

Figure 4.5: Actual expenditure compared with forecast expenditure, 2024–25 ($m)

Figure 4.5: Actual expenditure compared with forecast expenditure, 2024–25 ($m)

Source: ANAO analysis of the 2024–25 PDSSs.

4.13 For 2024–25, the key drivers (as disclosed in the PDSSs40) for the projects with a variance of over $100 million are outlined below.

  • SEA5000 Hunter Class Frigates — the project actual expenditure is $1,366.4 million, $621.5 million higher than the PBS ($744.9 million). The key driver for this variance is that ‘The project transitioned to the construction phase on 1 July 2024 with the commencement of construction of the first three ships’. The variance reflects the increased budget to fund the construction phase.
  • LAND400 Phase 2 Combat Reconnaissance Vehicles — the project actual expenditure is $351.5 million, an underspend of $284.7 million compared to the PBS ($636.2 million). The key driver for this variance ‘is primarily due to the rescheduling of contract milestones and deliveries’.
  • LAND4503 Apache Attack Helicopter — the project actual expenditure is $502.6 million, an overspend of $234.0 million compared to the PBS ($268.6 million). The key driver for this variance is ‘FMS activity forecast for FY 2024–25’.
  • LAND907 Armoured Combat — the project actual expenditure is $731.1 million, an overspend of $227.1 million compared to the PAES ($504.0 million). The key driver for this variance is ‘primarily due to higher than forecast FMS disbursements, and the unpredictable nature of the FMS program’.
  • SEA9100 IE Logistics Support Helicopter — the project actual expenditure is $274.0 million, an underspend of $152.8 million compared to the PBS ($426.8 million). The key drivers for this variance were ‘primarily attributed to delay in aircraft production and spares delivery slippage against FMS Case AT-P-SCO’ and ‘re-phasing of FMS disbursements to account for changes to aircraft production schedules, and timing of FMS disbursements’.
  • AIR6000 Joint Strike Fighter — the project actual expenditure is $239.7 million, an underspend of $130.4 million compared to the PBS ($370.0 million). The key driver for this variance is ‘primarily driven by cost savings from the Reprogramming Laboratory from the Canada buy-in into the ACURL Phase 2 program’.
  • SEA1180 Offshore Patrol Vessel — the project actual expenditure is $502.6 million, an overspend of $114.1 million compared to the PAES ($388.5 million). The key driver for this variance was ‘driven by payments to resolve commercial issues including verified scope reduction claims, offset by an underspend in production of OPV 1 to 6’.
  • AIR555 MC-55A Peregrine — the project actual expenditure is $116.1 million, an underspend of $108.1 million compared to the PBS ($224.2 million). The key driver for this variance is ‘due to rescheduling of aircraft modification and flight testing activities’, and ‘adjustments to FMS Case apportionment across acquisition and sustainment funding sources, as well as an underspend in FMS Case disbursements’.

4.14 Figure 4.6 identifies in-year actual expenditure variances as a percentage of PBS, PAES and in-year budget. This measure highlights the overspend variance between PBS to in-year actual expenditure (see Figure 4.5).

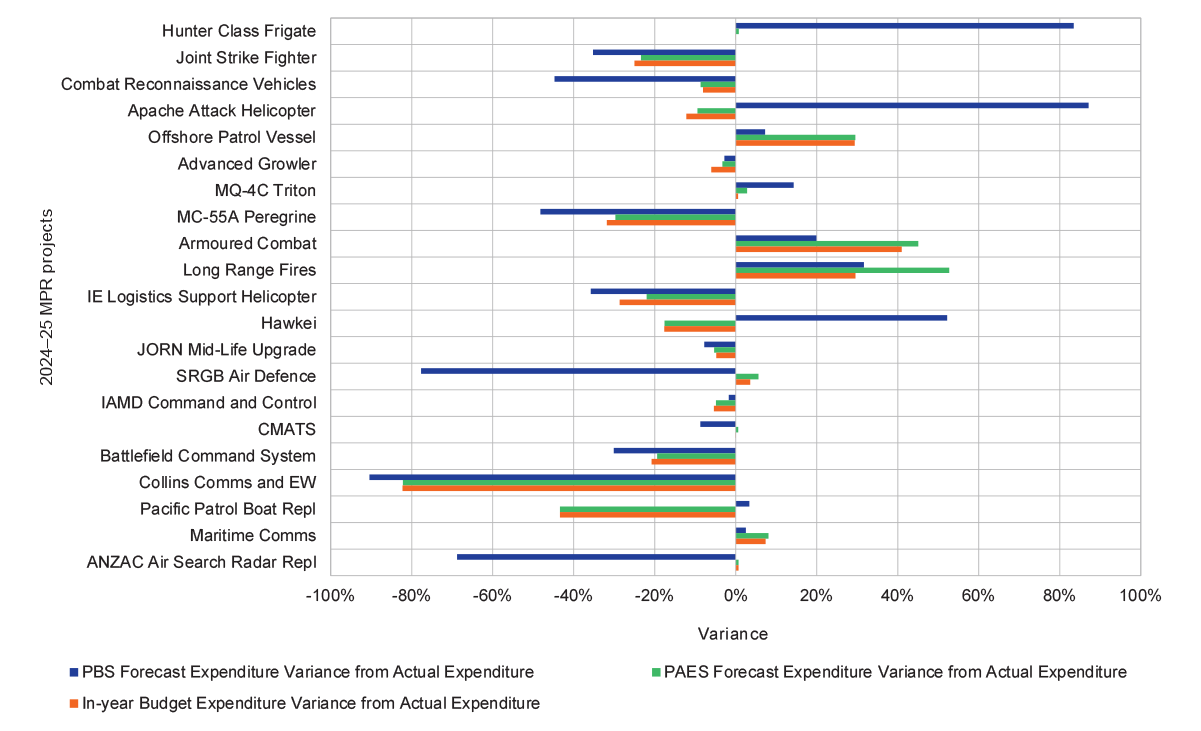

Figure 4.6: Actual expenditure compared with forecast expenditure, 2024–25 (%)

Figure 4.6: Actual expenditure compared with forecast expenditure, 2024–25 (%)

Source: ANAO analysis of the 2024–25 PDSSs.

4.15 Projects with over 50 per cent variance (not outlined in Paragraph 4.13) and key drivers as disclosed in the PDSSs41 are outlined below.

  • LAND8113 Phase 1 Long Range Fires — the project actual expenditure is an overspend of 52.7 per cent compared to the PAES. The key driver for this variance ‘is due to additional budget allocation related to funding for munitions acquisition Guided Weapons and Explosive Ordnance and Foreign Exchange Adjustments’.
  • LAND121 Phase 4 Hawkei — the project actual expenditure is an overspend of 52.2 per cent compared to the PBS. The key driver for this variance ‘is primarily due to the reprogramming of the underspend from FY 2023–24 into the FY 2024–25 due to the Hawkei safety brake issue’.
  • LAND19 7B Short Range Ground Based Air Defence — the project actual expenditure is an underspend of 77.7 per cent compared to the PBS. The project reports that the key driver for this variance occurred between PBS to PAES ‘primarily due to a number of minor procurement activities, operating cost and foreign exchange movements’.
  • SEA1439 Phase 5B2 Collins Comms and EW — the project actual expenditure is an underspend of 90.5 per cent compared to the PBS primarily due to ‘decrease in project management budget; reprogramming of FMS case budget, capability assurance activities and Stage 2 platform works’. The project actual expenditure is an underspend of 82.2 per cent compared to the PAES primarily due to ‘Variance is predominantly due to re-programming of long lead items and foreign exchange adjustment’. The project actual expenditure is an underspend of 82.3 per cent compared to the in-year budget primarily due to ‘Delays to overall progress of docking maintenance periods and consequential impact to completion of project milestones that are dependent on availability of a range of other platform system services; and FMS case disbursement lower than phased budget’.
  • SEA1448 Phase 4B ANZAC Air Search Radar Replacement — the project actual expenditure is an underspend of 68.8 per cent compared to the PBS. The key driver for this variance ‘is primarily due to a reduction in budget required for WAMA milestones ($5.3m) which appear to have slipped to FY 2025–26 and decrease in CEA Technologies Pty Ltd ($2.6m) driven by Contract Proposal 10 to reschedule milestones to incorporate AMCAP schedule delays and rescheduling of CEA Technologies Pty Ltd forecast to incorporate the PAR Simulator security requirement and ($0.9m) due to other expenses’.

Schedule performance

AIR5431 Phase 3 CMATS and SEA3036 Phase 1 Pacific Patrol Boat Replacement (which disclosed FOC), represent 34 per cent of the total value of schedule slippage.

4.16 The ANAO’s analysis of schedule performance for the 21 projects includes slippage by approval date, and original and in-year FOC forecasts.

4.17 Slippage is a term used for consistency in producing longitudinal analysis for comparison of schedule across years of the MPR. As discussed in paragraph 2.4, slippage is calculated based on the variance between original government second pass approval (when government originally expected capability to be available, known as the ‘Original Planned’ FOC date) and current project completion forecasts (known as the ‘Achieved/Forecast’ FOC date). Defence defines FOC as ‘The capability state relating to the in-service realisation of the final subset of a capability system that can be employed operationally’.

4.18 Slippage can occur due to late delivery, changes in scope, or at times can be a deliberate management or subsequent government decision (all changes to FOC regardless of basis must be approved by government). PDSSs also use the term ‘delayed from’ when explaining changes in delivery milestones from original planned dates to current forecasts.

4.19 In the absence of being able to report at project level due to the non-disclosure of key schedule information including FOC in the PDSSs42, analysis of the underlying basis for individual schedule slippage is no longer able to be provided with aggregate, average or median values selected as appropriate to present the PDSS information while minimising risk of unintentional disclosure.

4.20 As the projects in the MPR are delivered concurrently, applying median and average slippage is a measure of project delivery performance across the 21 projects. The median value, by excluding outliers, provides an indication of the typical impact on achieving FOC on a project-level basis. The median slippage and the average slippage are 21 months respectively (see Table 4.1). This analysis excludes SEA5000 Hunter Class Frigate, which did not have an FOC milestone approved by government and AIR6500 Integrated Air and Missile Defence Command and Control project, which has yet to define FOC.

4.21 The sum of individual project slippage across the 21 projects in the 2024–25 MPR is 404 months. This reflects the total required effort (in months) to complete the 21 projects, calculated from the original government second pass approval FOC milestone. It does not account for the fact that projects are delivered concurrently. Of the MPR projects that disclosed FOC, three projects represented 126 of the 404 months total slippage, or 34 per cent. These were: LAND200 Tranche 2 Battlefield Command System; SEA3036 Phase 1 Pacific Patrol Boat Replacement; and AIR5431 Phase 3 CMATS (93 months) which is a long-standing Project of Concern.

4.22 Further analysis of schedule variances between the ‘Original Planned’ FOC date to the ‘Achieved/Forecast’ FOC date for the 19 projects with an FOC identified the following.

  • Eight projects reported no slippage. This includes LAND200 Tranche 2 Battlefield Command System, which had an updated MAA in 2024–25 that redefined the project milestones, allowing the project to achieve FOC against the new baseline FOC.
  • Eleven projects reported slippage within an median slippage range of around two years. This is except for AIR5431 Phase 3 CMATS which accounts for 23 per cent of the total 404 months slippage.

4.23 As an outcome of the 2024 NDS and 2024 IIP rebuild, the scope and approved funding for AIR7000 Phase 1B MQ-4C Triton was removed from AIR7000 and established under a new project named AIR7001 MQ-4C Triton.43 This change resulted in re-baselining the IOC and FOC milestones.

Schedule slippage and acquisition category by approval date

Government-to-government arrangements have been demonstrating consistent improvement in meeting scheduled milestones since 2021.

4.24 Figure 4.7 shows the average schedule slippage (changes to FOC from original government second pass approval) for each acquisition approach since 2021–22 to 2024–25.

Figure 4.7: Average slippage by acquisition approach between 2020–21 and 2024–25 (months)a b

Figure 4.7: Average slippage by acquisition approach between 2020–21 and 2024–25 (months)

Note a: Slippage analysis excludes two Projects which did not have settled FOC dates as at 30 June 2025. SEA5000 Hunter Class Frigate did not have an FOC milestone approved by government and AIR6500 Integrated Air and Missile Defence Command and Control project has yet to define a FOC.

Note b: Average slippage for the ‘Other’ acquisition approach excludes data pertaining to the Battlefield Command System (LAND200 Tranche 2) in 2022–23 due to the Auditor-General’s Qualified Conclusion of that year, see paras. 2.8–2.9 and the Independent Assurance Report in Part 3 of that report.

Source: ANAO analysis of the 2020–21 to 2024–25 PDSSs.

4.25 The ANAO’s ability to analyse acquisition approaches and assess against schedule slippage is constrained by Defence’s use of not for publication information, particularly regarding FOC milestones in PDSSs. The decrease of GtG and other acquisition approaches in the 2024–25 MPR is primarily due to Defence re-baselining projects to align with the 2024 IIP, as discussed in paragraph 2.5. This process redefined the projects’ MAAs with new FOC dates, removing historically reported schedule slippage. The rising trend in other acquisition approaches is primarily impacted by the slippages incurred in AIR5431 Phase 3 CMATS.

Capability/scope performance

Scope forecasts and expected materiel deliverables have less at-risk components compared to prior years.

4.26 Defence defines capability as ‘the power to achieve a desired operational effect in a nominated environment within a specified time, and to sustain that effect for a designated period’.44 The capability reported in the PDSSs shows the current state of what the project will deliver, and not necessarily what the original intent was. In prior MPRs this component of the PDSSs was deemed out of scope of the ANAO’s review. From 2024–25, the Auditor-General has considered this to be in scope of the review. The ANAO’s analysis includes reporting on Defence’s delivery of materiel capability/scope.

4.27 The forecasted materiel capability/scope to be delivered by FOC for each project is presented in the PDSSs as traffic light style visualisation and allocated a percentage. This represents the breakdown of materiel (significant) delivery performance. The calculated percentage breakdown, which may be based on cost or another factor relevant to capability outcomes, should be aligned to the project’s Materiel Acquisition Agreement (MAA)45 and/or Government approval.

4.28 The expected materiel deliverables are assessed as ‘high confidence’ (green), ‘under threat’ (amber), ‘unlikely’ (red) or added/removed from scope. Figure 4.8 provides an overview of Defence’s expected capability/scope delivery between 2022–23 and 2024–25 (past three financial years).

Figure 4.8: Summary of expected capability/scope delivery by year

Figure 4.8: Summary of expected capability/scope delivery by year

Source: ANAO analysis of the 2024–25 PDSSs and previously published Defence PDSSs.

4.29 The data shows that as at 30 June 2025, Defence expects 97.7 per cent of agreed capability/scope across all 21 projects to be delivered. This was an increase of 3.2 per cent from 2023–24 (94.5 per cent). The materiel deliverables assessed as under threat or unlikely to be fully met accounted for 2.3 per cent, which was a decrease of 2.7 per cent from 2023–24.

Reporting on capability/scope delivery

Average delivery confidence has improved year on year since 2022–23.

4.30 In the 2024–25 MPR, 14 projects indicated that as at 30 June 2025, the project was confident that 100 per cent of the agreed capability/scope would be delivered in due course. This is represented by the ‘green’ traffic light rating in section 4 of the PDSSs.

4.31 In 2024–25, an updated MAA redefined project milestones for LAND200 Tranche 2 Battlefield Command System, impacting the reported delivery confidence level to fully meet stated capability materiel releases as set out in the MAA with the exception of key deliverables previously reported in the PDSS as in scope.46

4.32 The total figure for the ‘amber’ category demonstrates the projects confidence that as at 30 June 2025, a percentage of agreed capability/scope is considered at risk, although still likely to be delivered. This figure increased from 1.0 per cent in the 2022–23 MPR to 1.4 per cent in the 2023–24 MPR and reduced to 1.1 per cent in the 2024–25 MPR.

4.33 The share of all capability/scope (agreed as at 30 June in each review year) that is unlikely to be delivered or having been removed is the ‘red’ category in the table. This figure has improved from 6 per cent in the 2022–23 MPR to 3.6 per cent in the 2023–24 MPR and dropped further in the 2024–25 MPR to 1.2 per cent.

Capability delivery performance by acquisition approach

Projects acquired under a Foreign Military Sale have shown higher capability delivery performance than other acquisition approaches.

4.34 Of the common acquisition approaches used in the projects reported in the MPR over time, projects involving FMS and GtG arrangements have reported higher assessments of ‘green’ delivery confidence on average, representing greater certainty that the scope of the project will be delivered as planned. Since the 2020–21 MPR:

  • FMS approaches averaged 98.9 per cent ‘green’;
  • GtG approaches averaged 99.6 per cent ‘green’; and
  • Other (developmental or domestic acquisition) approaches averaged 94.8 per cent ‘green’.

Transfers of project scope

4.35 As part of Second Pass Approval, the government directs Defence to deliver certain defined capabilities within the scope of the approved project. During the life of a project, Defence may require a change to the scope or capability, which can be approved through a revised Government approval. This approval can expand or reduce the scope defined for FOC or consequently modify the budget for the project to deliver the revised capability requirements.

4.36 Transfers of scope were reported by Defence in Section 2.1 of four PDSSs, either as ‘Real Variation – Transfer’ or ‘Real Variation – Scope’. These transfers are described in Table 4.2 below.

Table 4.2: Transfers of scope as at 30 June 2025

Project

Description

AIR6000 Phase 2A/2B Joint Strike Fighter

2018a: Project scope worth $1.5 billion was transferred to future (unapproved) phases of the AIR6000 program, with no corresponding transfer of funds out of the project budget.

2023: Transfer to Security and Estate Group following request for funding scope changes for RAAF Base Tindal JSF facilities and transfer of scope to AIR6000 Phase 6.

AIR2025 Phase 6 JORN Mid-Life Upgrade

2020: Project scope worth $2.5 million was transferred in from Estate and Infrastructure Group (E&IG) to support AIR2025 Phase 6, which included replacing a facility at the Radar 3 Transmit site which is best delivered by the JORN Prime Contractor, as it involves specialist fit out and coordinated delivery within JORN operational constraints.

LAND200 Tranche 2 Battlefield Command System

2022: 38 Protected Mobility Vehicle – Medium (PMV-M) Gate Way vehicles originally within the Project’s scope will be delivered by the LAND4111 Project.

LAND8113 Phase 1 Long Range Fires

2025: The Australian Government announced the requirement for 15 Bushmaster Command Variants (Bushmasters) to support the project. As a result, additional Bushmasters have been requested via LAND4111 Phase 1 – Protected Military Mobilisation projects existing agreement with Thales. These will be acquired using Long Range Fires existing project funds.

Note a: The transfer for AIR6000 Phase 2A/2B Joint Strike Fighter was reported in Auditor-General Report No. 19 2019–20 2018–19 Major Projects Report, paragraphs 1.38 to 1.39.

Source: ANAO analysis of the 2024–25 PDSSs and previously published Defence PDSSs.

4.37 In 2024–25, LAND8113 Phase 1 Long Range Fires contracted the acquisition of 15 Bushmaster vehicles through another project — LAND4111 Phase 1 Protected Military Mobilisation. This is being paid for through the existing project funds attached to the LAND8113 Phase 1 Long Range Fires project. This has not been reported as an increase in scope within the project’s PDSS as the MAA has not been impacted.

Longitudinal data on project performance

Of the 14 projects in the MPR between 2020–21 and 2024–25, reported risks and issues have decreased, and delivery confidence levels have improved.

4.38 Table 4.3 to Table 4.5 outlines the longitudinal data across key project performance indicators for 14 projects that have been in the MPR across five consecutive years, as well as the seven projects that did not form part of the longitudinal analysis (identified by italic text in the tables). This includes approval budget, schedule slippage (for projects not subject to Defence non-disclosure provisions), the confidence level for scope or capability delivery, and changes in the number of risk and issues reported over time. Each of these are broken down by domain – SEA, LAND and AIR.

Table 4.3: Project performance longitudinal data, SEA domain, 2020–21 to 2024–25

SEA

MPR Review year

2020–21

2021–22

2022–23

2023–24

2024–25

SEA5000 Hunter Class Frigate

Total approved budget as at 30 June ($m)

6,046.9

6,055.7

6,148.2

25,924.0

26,055.3

Remaining budget ($m)

4,827.9

4,228.2

3,578.5

22,286.1

21,051.0

Schedule slippage (months)

N/A

N/A

N/A

N/A

N/A

Confidence level of capability/scope delivery (%)

N/A

N/A

N/A

N/A

100

Reported number of risks and issues

15 risks 3 issues

10 risks 3 issues

5 risks Nil issues

4 risks Nil issues

8 risks 1 issue

SEA1180 Phase 1 Offshore Patrol Vessel

Total approved budget as at 30 June ($m)

3,669.6

3,648.6

3,664.1

3,704.8

3,707.4

Remaining budget ($m)

2,856.2

2,603.7

2,327.6

2,150.1

1,650.1

Schedule slippage (months)

0

NFP

0

NFP

NFP

Confidence level of capability/scope delivery (%)

100

99.6

99.6

62.8

98.5

Reported number of risks and issues

3 risks Nil issues

5 risks Nil issues

7 risks Nil issues

8 risks 2 issues

7 risks 3 issues

SEA1439 Phase 5B2 Collins Comms and EW

Total approved budget as at 30 June ($m)

608.7

610.1

614.2

616.1

617.8

Remaining budget ($m)

249.7

227.5

210.1

196.9

195.7

Schedule slippage (months)

30

30

30

NFP

NFP

Confidence level of capability/scope delivery (%)

100

100

100

100

100

Reported number of risks and issues

3 risks 2 issues

2 risks 2 issues

4 risks 2 issues

1 risk 7 issues

2 risks 6 issues

SEA3036 Phase 1 Pacific Patrol Boat Replacement

Total approved budget as at 30 June ($m)

501.4

502.3

502.9

517.5

568.5

Remaining budget ($m)

250.6

190.1

141.3

104.1

122.2

Schedule slippage (months)

2

TBA

12

NFP

33

Confidence level of capability/scope delivery (%)

100

0

100

90

100

Reported number of risks and issues

2 risks 1 issue

4 risks 1 issue

4 risks 2 issues

3 risks 1 issue

Nil risks Nil issues

SEA1442 Phase 4 Maritime Comms

Total approved budget as at 30 June ($m)

434.1

434.8

436.4

441.8

443.2

Remaining budget ($m)

182.6

158.9

136.3

121.3

100.9

Schedule slippage (months)

16

16

NFP

NFP

NFP

Confidence level of capability/scope delivery (%)

100

100

100

100

100

Reported number of risks and issues

5 risks 2 issues

1 risk 4 issues

1 risk 4 issues

Nil risks 1 issue

1 risk 2 issues

SEA1448 Phase 4B ANZAC Air Search Radar Replacement

Total approved budget as at 30 June ($m)

429.1

429.2

429.5

429.4

429.5

Remaining budget ($m)

116.9

97.9

82.5

71.7

67.7

Schedule slippage (months)

0

-1

-1

NFP

NFP

Confidence level of capability/scope delivery (%)

100

100

99.9

100

100

Reported number of risks and issues

3 risks 4 issues

4 risks 5 issues

3 risks 4 issues

Nil risks 4 issues

Nil risks 1 issue

SEA9100 Phase 1 IE Logistics Support Helicopter

Total approved budget as at 30 June ($m)

1,710.4

2,086.1

Remaining budget ($m)

1,491.9

1,593.5

Schedule slippage (months)

NFP

NFP

Confidence level of capability/scope delivery (%)

100

100

Reported number of risks and issues

Nil risks Nil issues

Nil risks 1 issue

Source: ANAO analysis of the 2024–25 PDSSs and previously published Defence PDSSs.

Table 4.4: Project performance longitudinal data, LAND domain, 2020–21 to 2024–25

LAND

MPR Review year

2020–21

2021–22

2022–23

2023–24

2024–25

LAND400 Phase 2 Combat Reconnaissance Vehicles

Total approved budget as at 30 June ($m)

5,655.4

5,606.3

5,657.3

5,774.7

5,775.6

Remaining budget ($m)

4,174.5

3,755.3

3,236.8

2,984.8

2,634.2

Schedule slippage (months)

0

0

0

NFP

NFP

Confidence level of capability/scope delivery (%)

100

100

100

100

100

Reported number of risks and issues

8 risks 5 issues

5 risks 6 issues

1 risk 4 issues

6 risks 7 issues

8 risks 8 issues

LAND121 Phase 4 Hawkei

Total approved budget as at 30 June ($m)

1,952.9

1,962.9

1,971.5

1,976.0

1,975.5

Remaining budget ($m)

766.9

435.8

290.5

280.8

265.4

Schedule slippage (months)

0

0

12

TBA

NFP

Confidence level of capability/scope delivery (%)

100

99.8

99.8

99.9

99.9

Reported number of risks and issues

5 risks 3 issues

3 risks 1 issue

4 risks 1 issue

1 risk 6 issues

1 risk 2 issues

LAND19 Phase 7B SRGB Air Defence

Total approved budget as at 30 June ($m)

1,201.0

1,216.3

1,232.8

1,241.1

1,245.7

Remaining budget ($m)

752.8

584.4

410.8

218.3

195.2

Schedule slippage (months)

0

0

0

NFP

NFP

Confidence level of capability/scope delivery (%)

100

100

100

100

93.7

Reported number of risks and issues

2 risks Nil issues

3 risks 1 issue

4 risks Nil issues

2 risks Nil issues

2 risks 1 issue

LAND200 Tranche 2 Battlefield Command Systema

Total approved budget as at 30 June ($m)

962.3

966.2

971.4

972.5

972.7

Remaining budget ($m)

320.8

304.7

208.0

183.1

158.5

Schedule slippage (months)

16

38

NFP

NFP

0

Confidence level of capability/scope delivery (%)

91

48

48

60.5

76.1

Reported number of risks and issues

7 risks 8 issues

3 risks 12 issues

4 risks 7 issues

3 risks 2 issues

3 risks Nil issues

LAND4503 Apache Attack Helicopter

Total approved budget as at 30 June ($m)

4,560.4

4,685.0

Remaining budget ($m)

4,221.5

3,833.5

Schedule slippage (months)

NFP

NFP

Confidence level of capability/scope delivery (%)

100

100

Reported number of risks and issues

1 risk Nil issues

1 risk Nil issues

LAND907 Armoured Combat

Total approved budget as at 30 June ($m)

2,283.0

2,359.6

2,388.4

Remaining budget ($m)

2,130.8

1,577.6

875.2

Schedule slippage (months)

NFP

NFP

NFP

Confidence level of capability/scope delivery (%)

100

100

100

Reported number of risks and issues

0 risks 0 issues

0 risks 0 issues

0 risks 0 issues

LAND8113 Phase 1 Long Range Fires

Total approved budget as at 30 June ($m)

2,388.5

Remaining budget ($m)

2,142.6

Schedule slippage (months)

NFP

Confidence level of capability/scope delivery (%)

100

Reported number of risks and issues

5 risks Nil issues

Note a: In 2022–23, the Auditor-General qualified LAND200 Tranche 2 Battlefield Command System’s PDSS due to material inconsistency between disclosures and evidence, including in Section 4.1 (Measures of Materiel Capability/Scope Delivery Performance) – percentages shown against the ‘amber’ and ‘red’ indicators.

Source: ANAO analysis of the 2024–25 PDSSs and previously published Defence PDSSs.

Table 4.5: Project performance longitudinal data, AIR domain, 2020–21 to 2024–25

AIR

MPR Review year

2020–21

2021–22

2022–23

2023–24

2024–25

AIR6000 Phase 2A/2B Joint Strike Fighter

Total approved budget as at 30 June ($m)

15,630.7

15,795.7

16,424.6

16,589.1

16,708.1

Remaining budget ($m)

6,589.3

5,052.6

4,591.6

4,178.4

4,057.8

Schedule slippage (months)

0

0

NFP

NFP

NFP

Confidence level of capability/scope delivery (%)

99

99

99.9

100

100

Reported number of risks and issues

8 risks 2 issues

9 risks 3 issues

6 risks 5 issues

1 risk 2 issues

1 risk 1 issue

AIR7001 MQ-4C Triton

Total approved budget as at 30 June ($m)

1,953.4

1,999.5

2,403.7

2,447.7

2,444.3

Remaining budget ($m)

1,544.5

1,339.2

1,477.6

1,262.6

966.1

Schedule slippage (months)

66

66

66

NFP

NFP

Confidence level of capability/scope delivery (%)

100

100

99

99

99

Reported number of risks and issues

7 risks 1 issue

6 risks Nil issues

6 risks Nil issues

6 risks Nil issues

5 risks Nil issues

AIR2025 Phase 6 JORN Mid-Life Upgrade

Total approved budget as at 30 June ($m)

1,128.5

1,146.2

1,288.0

1,285.6

1,250.4

Remaining budget ($m)

939.1

894.8

933.1

834.7

711.6

Schedule slippage (months)

N/A

NFP

NFP

NFP

NFP

Confidence level of capability/scope delivery (%)

100

100

99.9

100

100

Reported number of risks and issues

4 risks Nil issues

4 risks Nil issues

6 risks 1 issue

6 risks Nil issues

4 risks Nil issues

AIR5431 Phase 3 CMATS

Total approved budget as at 30 June ($m)

974.5

1,010.8

1,010.0

1,010.0

1,010.9

Remaining budget ($m)

554.6

491.8

398.8

367.8

323.2

Schedule slippage (months)

46

57

56

87

93

Confidence level of capability/scope delivery (%)

100

100

100

100

100

Reported number of risks and issues

20 risks 5 issues

20 risks 5 issues

16 risks 4 issues

16 risks 7 issues

12 risks 4 issues

AIR5349 Phase 6 Advanced Growler

Total approved budget as at 30 June ($m)

3,200.1

3,222.2

3,287.0

Remaining budget ($m)

2,718.4

2,469.4

2,290.1

Schedule slippage (months)

NFP

NFP

NFP

Confidence level of capability/scope delivery (%)

100

100

100

Reported number of risks and issues

1 risk Nil issues

3 risks Nil issues

5 risks Nil issues

AIR555 MC-55A Peregrine

Total approved budget as at 30 June ($m)

2,233.6

2,360.2

2,394.8

2,399.4

Remaining budget ($m)

735.2

669.3

559.7

448.3

Schedule slippage (months)

NFP

NFP

NFP

NFP

Confidence level of capability/scope delivery (%)

100

100

90

97

Reported number of risks and issues

11 risks 3 issues

12 risks 3 issues

9 risks 3 issues

6 risks 3 issues

AIR6500 Integrated Air Missile Defence Command and Control

Total approved budget as at 30 June ($m)

1,097.2

Remaining budget ($m)

497.9

Schedule slippage (months)

NFP

Confidence level of capability/scope delivery (%)

87

Reported number of risks and issues

3 risks 1 issue

Source: ANAO analysis of the 2024–25 PDSSs and previously published Defence PDSSs.

!Part 2. Defence Major Projects Report

Part 2. Defence Major Projects Report is available to download in a separate PDF file, or in the complete report PDF which is available to download at Related documents on this page.

!Part 3. Assurance by the Auditor-General and the Secretary of Defence

Independent Assurance Report by the Auditor-General

Independent Assurance Report by the Auditor-General page 1

Independent Assurance Report by the Auditor-General page 2

Independent Assurance Report by the Auditor-General page 3

Independent Assurance Report by the Auditor-General page 4

Independent Assurance Report by the Auditor-General page 5

Statement by the Secretary of Defence

Statement by the Secretary of Defence  page 1

Statement by the Secretary of Defence  page 2

Statement by the Secretary of Defence  page 3

Statement by the Secretary of Defence  page 4

!Part 4. JCPAA 2024–25 Major Projects Report Guidelines

The JCPAA 2024–25 Major Projects Report Guidelines part is available to download in a separate PDF file, or in the complete report PDF which is available to download at Related documents on this page.

Footnotes

1 Foreign Affairs, Defence and Trade References Committee, Report on the inquiry into materiel acquisition and management in Defence, March 2003, p. xv, available from https://www.aph.gov.au/~/media/wopapub/senate/committee/fadt_ctte/completed_inquiries/2002_04/dmo/report/report_pdf.ashx [accessed 14 October 2025].

2 Auditor-General Report No. 9 2008–09, Major Projects Report 2007–08, available from https://www.anao.gov.au/work/major-projects-report/major-projects-report-2007-08 [accessed 14 October 2025].

3 Australian Government, National Defence: Defence Strategic Review 2023, Canberra, 23 April 2023, available from https://www.defence.gov.au/about/reviews-inquiries/defence-strategic-review [accessed 3 November 2025].

4 Australian Government, National Defence Strategy 2024, Canberra, April 2024, pp. 28-29, available from https://www.defence.gov.au/about/strategic-planning/2024-national-defence-strategy-2024-integrated-investment-program [accessed 3 November 2025].

5 The National Defence Strategy 2024 identifies the six key capability effects as: project force; hold a potential adversary’s forces at risk; protect ADF forces and supporting critical infrastructure in Australia; sustain protracted combat operations; maintain persistent situational awareness in our primary area of military interest; and achieve decision advantage.

6 Australian Government, Integrated Investment Program 2024, Canberra, April 2024, pp. 6-7, available from https://www.defence.gov.au/about/strategic-planning/2024-national-defence-strategy-2024-integrated-investment-program [accessed 3 November 2025].

7 Joint Committee of Public Accounts and Audit, Parliament of the Commonwealth of Australia, Report 483: Inquiry into the 2018–19 Defence Major Projects Report and the Future Submarine Project – Transition to Design (Auditor-General’s Reports 19 and 22 (2019–20)), (2020), Objective of the Major Projects Report, p. 6, available from https://www.aph.gov.au/Parliamentary_Business/Committees/Joint/Public_Accounts_and_Audit/2018-19DefenceMPR/Report [accessed 16 November 2024].

8 These standards incorporate the Australian Standard on Assurance Engagements (ASAE) 3000 Assurance Engagements Other than Audits or Reviews of Historical Financial Information, issued by the Australian Auditing and Assurance Standards Board.

9 The 2024–25 MPR Guidelines serve several key functions: establish the criteria used to select which projects will be included in the report and present the official list of those projects; define the roles and responsibilities of Defence in producing and assuring the quality of its contributions to the MPR; set out the requirements for preparing the PDSSs; provide the official PDSS template; and outline an indicative program schedule.

10 Auditor-General Report No. 50 2024–25 Department of Defence’s Sustainment of Canberra Class Amphibious Assault Ships (Landing Helicopter Dock, ANAO, Canberra, 2025, available at https://www.anao.gov.au/work/performance-audit/department-of-defence-sustainment-of-canberra-class-amphibious-assault-ships-landing-helicopter-dock [accessed 1 October 2025].

11 Auditor-General Report No. 46 2024–25 Management of the OneSky Contract, ANAO, Canberra, 2025, available at https://www.anao.gov.au/work/performance-audit/management-of-the-onesky-contract [accessed 1 October 2025].

12 Auditor-General Report No. 31 2024–25 Maximising Australian Industry Participation through Defence Contracting, ANAO, Canberra, 2025, available at https://www.anao.gov.au/work/performance-audit/maximising-australian-industry-participation-through-defence-contracting [accessed 1 October 2025].

14 The performance audit is reviewing LAND400 Phase 3, however the MPR reviews LAND400 Phase 2.

15 Department of Defence, 2025-29 Defence Corporate Plan, Defence, Canberra 2025 available at https://www.defence.gov.au/sites/default/files/2025-08/Defence-Corporate-Plan-2025-29.pdf [accessed 20 November 2025].

16 Joint Committee of Public Accounts and Audit, Report 507 Defence 2022–23 Major Projects Report, JCPAA, Canberra, 2024, available from https://www.aph.gov.au/Parliamentary_Business/Committees/Joint/Public_Accounts_and_Audit/MPR2022-23/Defence_202223_Major_Projects_Report [accessed 1 October 2025].

17 Due to the announcement of the Federal Election in 2025, the Parliament was dissolved on 28 March 2025. The 48th Parliament commenced on 22 July 2025. The current JCPAA adopted an inquiry into the 2023–24 MPR on 31 July 2025.

18 The 14 projects are: AIR6000 Phase 2A/2B Joint Strike Fighter; AIR2025 Phase 6 JORN Mid-Life Upgrade; AIR7001 MQ-4C Triton; AIR5431 Phase 3 CMATS; LAND19 Phase 7B SRGB Air Defence; LAND200 Tranche 2 Battlefield Command System; LAND400 Phase 2 Combat Reconnaissance Vehicles; LAND121 Phase 4 Hawkei, SEA1180 Phase 1 Offshore Patrol Vessel; SEA5000 Hunter Class Frigate; SEA1439 Phase 5B2 Collins Comms and EW; SEA3036 Phase 1 Pacific Patrol Boat Replacement; SEA1442 Phase 4 Maritime Comms; SEA1448 Phase 4B ANZAC Air Search Radar Replacement.

19 Forecast dates related to Section 3.1 Design Review Progress, Section 3.2 Contractor Test and Evaluation Progress, Section 3.3 Progress Toward Materiel Release and Operational Capability Milestones and Section 4.2 Constitution of Materiel Release and Operational Capability Milestones.

20 VCDF removed the NFP marking of milestone dates in the 2024–25 PDSS.

21 Joint Committee of Public Accounts and Audit, Report 503: Inquiry into the Defence Major Projects Report 2020–21 and 2021–22 and Procurement of Hunter Class Frigates, JCPAA, Canberra, 2024, available from https://parlinfo.aph.gov.au/parlInfo/download/committees/reportjnt/RB000337/toc_pdf/Report503InquiryintotheDefenceMajorProjectsReport2020-21and2021-22andProcurementofHunterClassFrigates.pdf [accessed 1 October 2025].

22 Joint Committee of Public Accounts and Audit, Report 507: Defence 2022–23 Major Projects Report, JCPAA, Canberra, 2024, available from https://parlinfo.aph.gov.au/parlInfo/download/committees/reportjnt/RB000358/toc_pdf/Report507.pdf [accessed 1 October 2025].

23 Department of Defence, National Defence Strategy, Defence, Canberra, 2024, available from https://www.defence.gov.au/about/strategic-planning/2024-national-defence-strategy-2024-integrated-investment-program [accessed 1 October 2025].

24 An action is where the ANAO has identified corrections in the PDSSs required to be taken by Defence to provide additional information, clarification or to address compliance with the 2024–25 MPR Guidelines.

25 Historically the ANAO would undertake three reviews of the PDSSs. In 2024–25 the ANAO decided to undertake two reviews to improve efficiency, and this decision was made possible in part due to the improved quality of the 2024–25 PDSSs prepared by Defence.

26 Joint Committee of Public Accounts and Audit, Parliament of the Commonwealth of Australia, Report 507: Inquiry into the 2022–23 Major Projects Report (Auditor-General’s Reports 20 of 2024–25, (2024), List of recommendations, p. xv, available from, https://www.aph.gov.au/Parliamentary_Business/Committees/Joint/Public_Accounts_and_Audit/MPR2022-23/Defence_202223_Major_Projects_Report [accessed 20 November 2025].

27 Department of Defence, CASG Project Controls Manual, Acronyms, Abbreviations and Definitions, 2017, p. 8.

28 Defence defines a caveat as a plan, stipulation, condition or limitation to mitigate the capability impact of a deficiency. Deficiency is defined as a shortfall between the Government agreed requirements and that which is provided at the milestone.

29 In the previous 2023–24 MPR, Defence published three caveats within the PDSSs. No deficiencies were declared. This number does not include any caveats or deficiencies that were deemed not for publication.

30 Auditor-General Report No. 14 2023–24, 2022–23 Major Projects Report, ANAO, Canberra, para. 1.77 (Collins Comms and EW and ANZAC Air Search Radar Repl.). Auditor-General Report No. 20 2024–25, 2023–24 Major Projects Report, ANAO, Canberra, para. 1.82 (Overlander and ANZAC Air Search Radar Repl.).

31 The seven projects were: AIR2025; LAND400; LAND907 / LAND8160; LAND8113; SEA9100; SEA3036; and SEA1448.

32 Joint Committee of Public Accounts and Audit, Parliament of the Commonwealth of Australia, Inquiry into Defence Major Projects Report (Auditor-General’s report Nos 19 and 22 (2019–20)), 27 May 2020, Group Business Manager Department of Defence.

33 AirServices Australia is responsible for delivering CMATs and supplying the Defence component. See Auditor-General Report No. 46 2024–25 Management of the OneSky Contract, available at https://www.anao.gov.au/work/performance-audit/management-of-the-onesky-contract [accessed 4 November 2025].

34 Joint Committee of Public Accounts and Audit, Report 503: Inquiry into the Defence Major Projects Report 2020–21 and 2021–22 and Procurement of Hunter Class Frigates, Canberra, 2024, para. 1.7. F.

35 Auditor-General Report No. 14 2023–24 2022–23 Major Projects Report, para. 1.92: ‘Application controls assessed by the ANAO related to data input; data manipulation; and data output. Not all system controls were tested.’

36 There were four projects in the 2023–24 MPR: Joint Strike Fighter, ANZAC Air Search Radar Repl, Overlander Medium/Heavy and Hawkei.

37 Real Variations can include ‘scope’ changes attributable to changes in requirements by Defence and government; ‘transfers’ which occur when a portion of the budget and corresponding scope is transferred to or from another approved project or sustainment product in Defence; ‘budgetary adjustments’ made to account for corrections resulting from foreign exchange or indexation accounting estimation errors; ‘real cost increases’, where funds have been approved by government to increase the project budget (generally without a change in scope); and ‘real cost decreases’ are where funds have been handed back to the Defence portfolio.

38 These are variations to the Original Approved project cost due to foreign exchange adjustments brought about by changes in foreign exchange rates for payments in foreign currency.

39 Department of Finance, Portfolio Budget Statements guidance, Finance, Canberra, 2025, available at https://www.finance.gov.au/government/managing-commonwealth-resources/managing-money-property/managing-money/annual-appropriations/portfolio-budget-statements [accessed 1 November 2025].

40 In Part 3 of this report, see the individual project PDSS, Section 2.2A In-year Budget Estimate Variance, ‘Explanation of Material Movements’ and Section 2.2B In-year Budget/Expenditure Variance, ‘Explanation’.

41 In Part 3 of this report, see the individual project PDSS, Section 2.2A In-year Budget Estimate Variance, ‘Explanation of Material Movements’ and Section 2.2B In-year Budget/Expenditure Variance, ‘Explanation’.

42 In the 2024–25 MPR, out of the 21 projects, three projects disclosed FOC — LAND200 Tranche 2 Battlefield Command System, AIR5431 Phase 3 CMATS and SEA3036 Phase 1 Pacific Patrol Boat Replacement. SEA5000 Hunter Class Frigate did not have an FOC milestone approved by government and AIR6500 Integrated Air and Missile Defence Command and Control has yet to define FOC. The remaining 16 projects did not disclose FOC on the basis of ‘not for publication’ resulting from Defence’s security review. The full list of the PDSSs and the respective sections, which have been marked as NFP by Defence is in the Auditor-General’s Independent Assurance Report in Part 3 of this report.

43 In Part 3 of this report, see the PDSS for AIR7001 PDSS Section 1.3 – Background.

44 Department of Defence, One Defence Capability System Manual, Defence, Canberra, 2025, available at https://www.defence.gov.au/business-industry/industry-governance/one-defence-capability-system-manual [accessed 1 October 2025].

45 MAAs are internal agreements between CASG/NSSG and the military service chiefs, which relate to product delivery and set out a project’s approved activities, costs and milestones.

46 In Part 3 of this report, see the PDSS for LAND200 PDSS Section 1.3 – Background and Section 4.1 Measures of Materiel Capability/Scope Delivery Performance.
